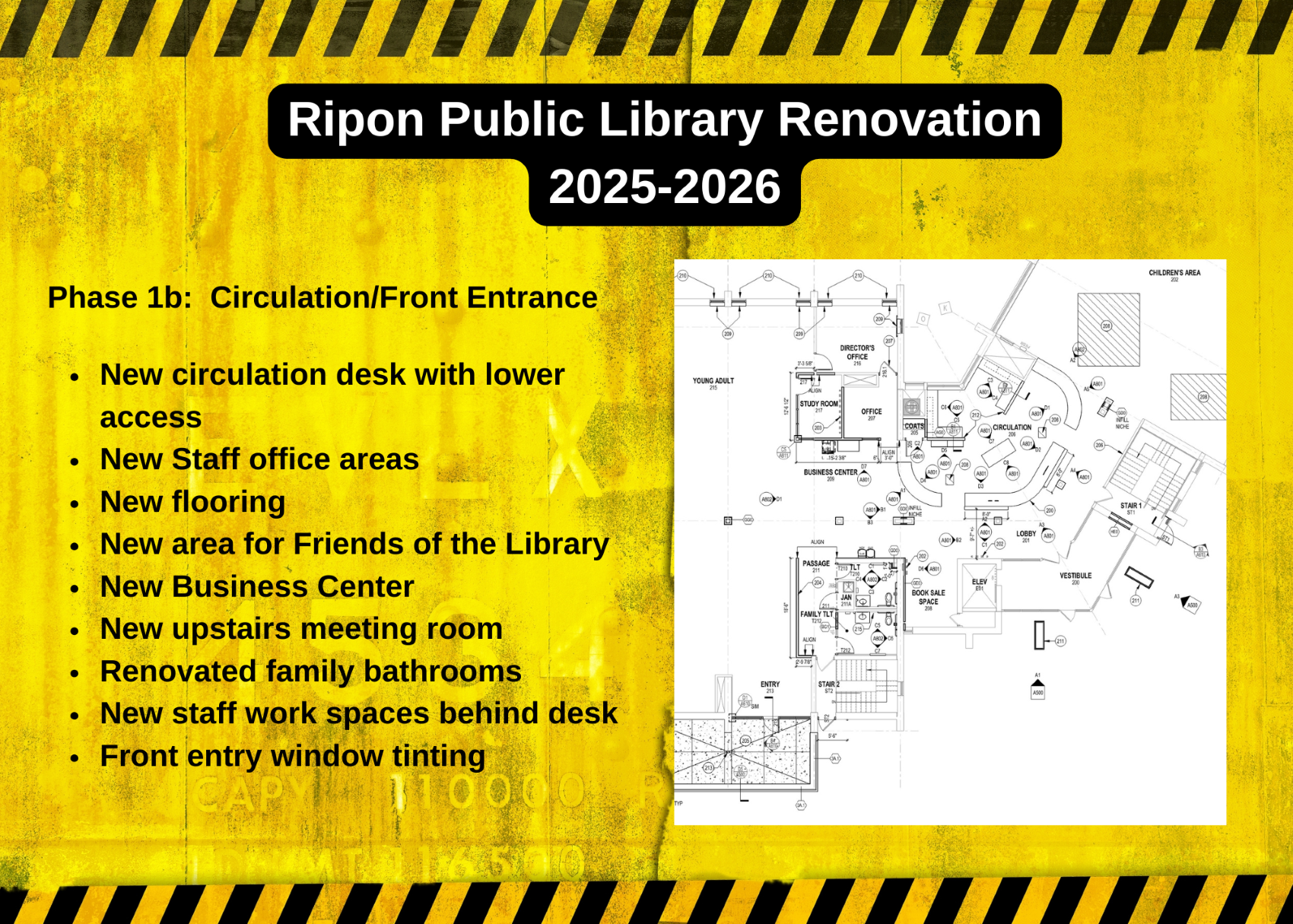

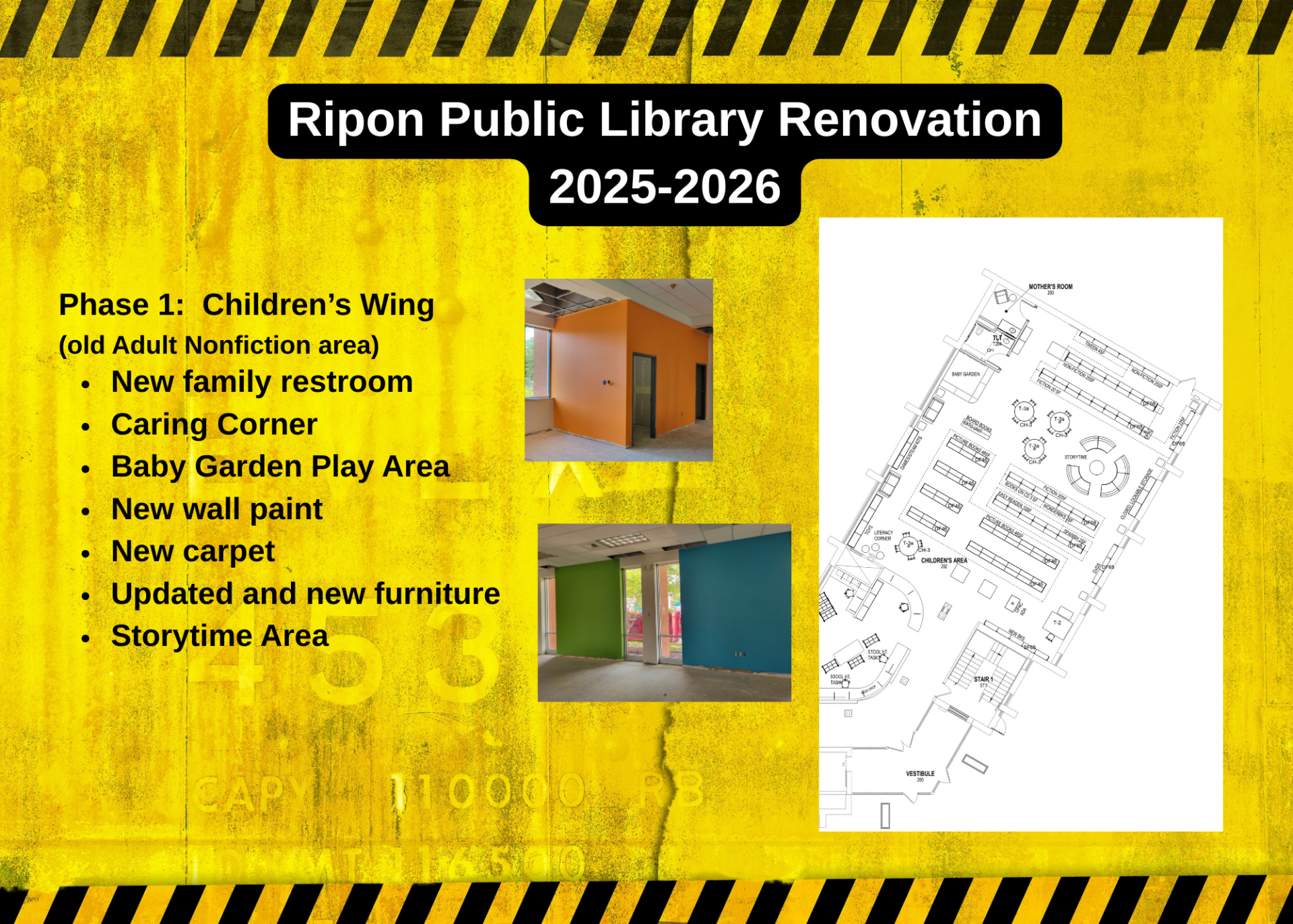

Renovation 2025-2026

Phase 2 (starting February 16)

Apart from a few odds and ends, the newly renovated children’s wing is complete! A selection of material for adults and teens, including fiction, nonfiction, large print, and DVDs, has been temporarily relocated to the lower level and is open for browsing from 9-5 weekdays. Outside of those hours, library staff will be happy to retrieve specific titles for you as time allows. The remainder of the library’s collections remain in storage until the completion of Phase 2 (target date: mid-June 2026). Public computer stations and printing services are available on the library’s main level.

Please respect signs, barrels, cones, etc. and stay out of work areas!

Patrons entering active construction areas constitute a major safety risk and could force the closure of the library to the public during renovations.

Some collections in storage

Due to space limitations, some collections have moved into long-term storage until the end of Phase 2. We are happy to assist patrons with requesting material from other libraries during this time via our weekday van delivery service.

Collections in storage include:

  • Audio Books
  • Biographies
  • Board Games
  • Local History
  • Music CDs
  • Paperbacks
  • Mysteries
  • Ripon Rifle & Pistol Club
  • Sci-Fi
  • Westerns
  • Young Adult Graphic Novels
  • Young Adult Nonfiction

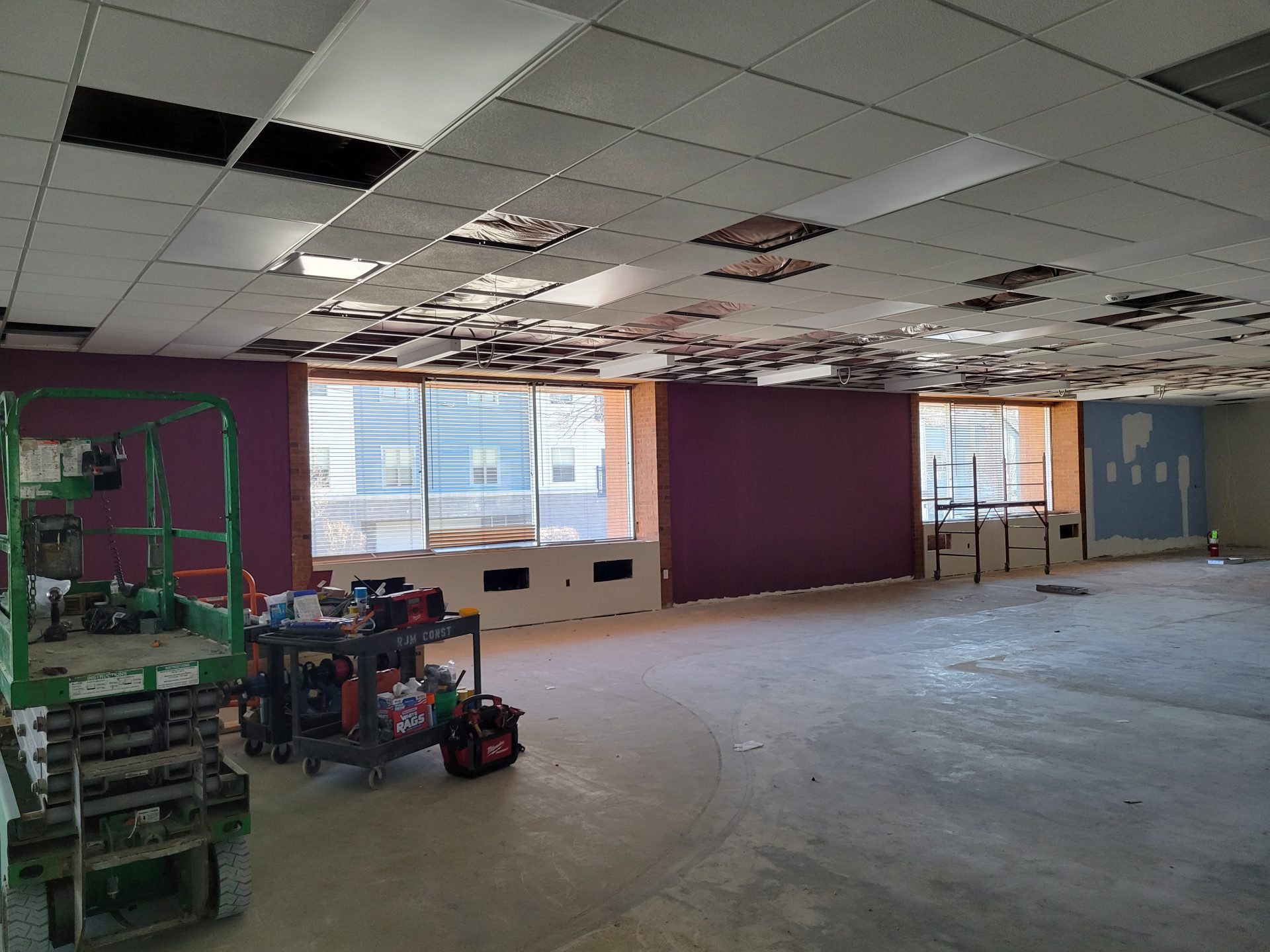

Outdoor work

Most exterior work has been completed. Construction crews will continue replacing older windows. The parking lot will be reconfigured into a one-way traffic flow later this year. The new drive-up book return has bene delayed but is still part of the renovation plan.

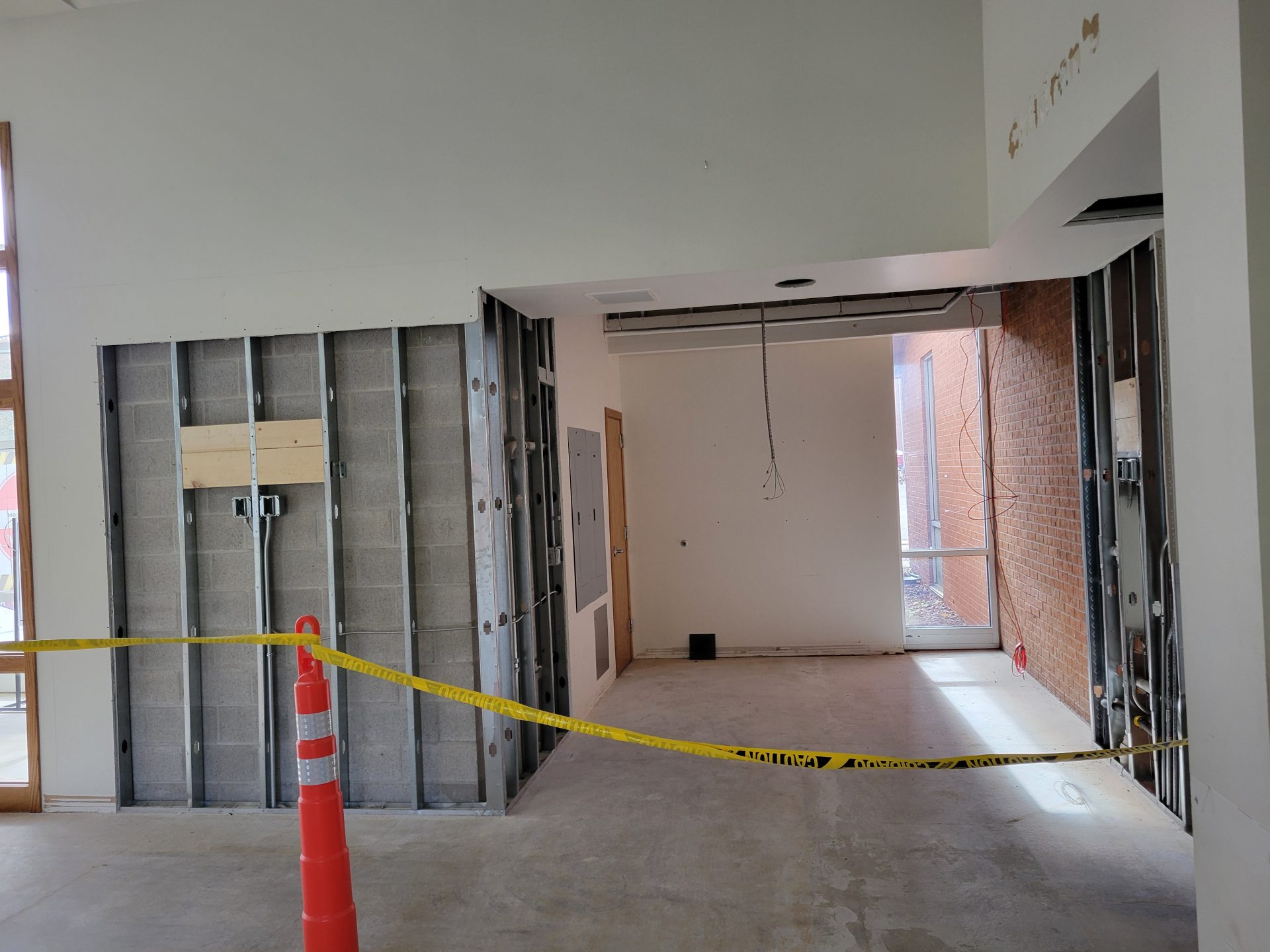

Image for timeline date 3/17/2026

Painting happening on the new upstairs meeting room!

Image for timeline date 3/17/2026

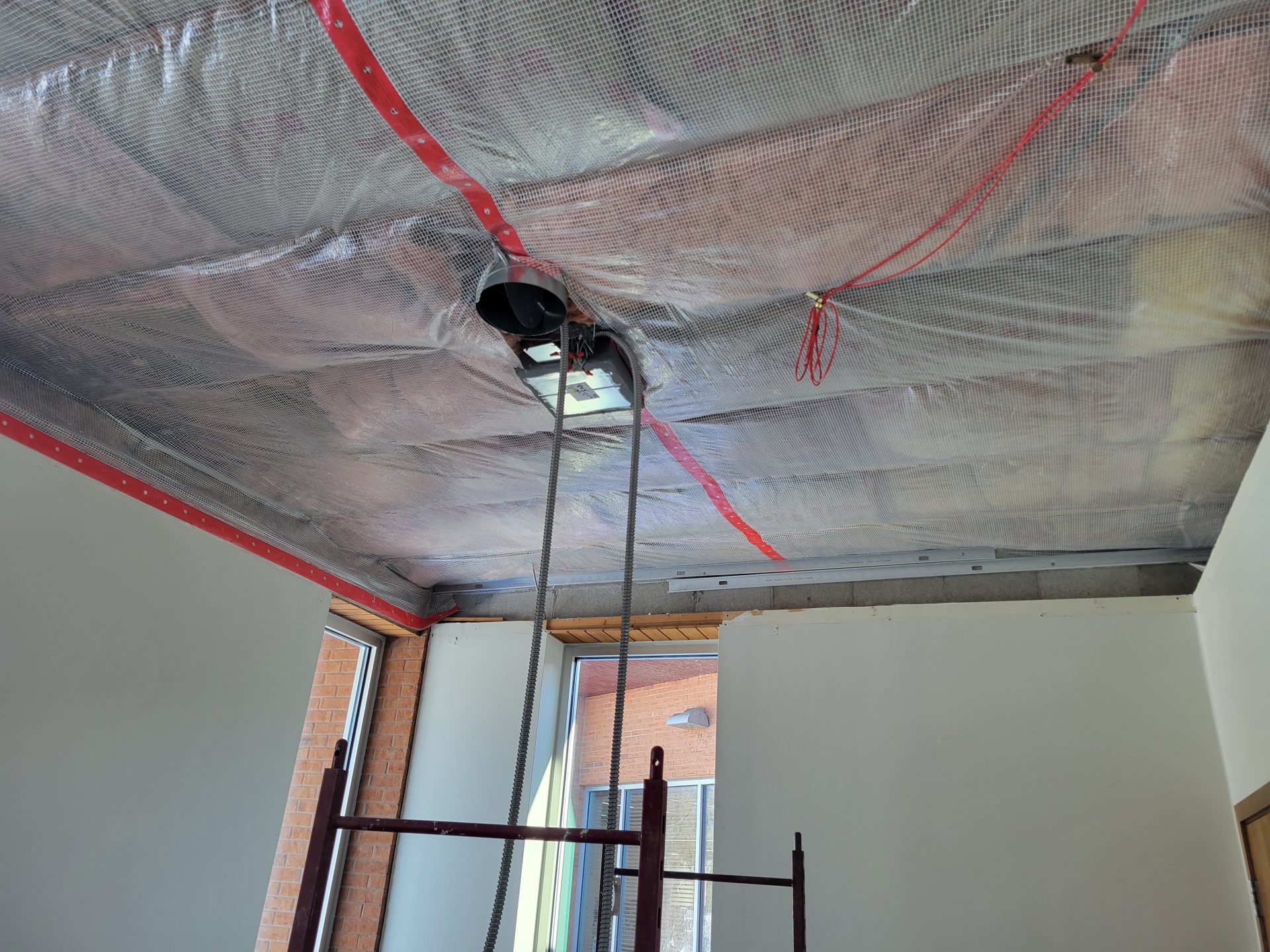

Director's office gets additional insulation!

Image for timeline date 3/10/2026

Upstairs meeting room getting roughed in!

Image for timeline date 3/10/2026

Director's office getting updates!

Image for timeline date 03/05/2026

Babygarten installed!

Image for timeline date 3/05/2026

New furniture in Children's Department!

Image for timeline date 2/26/2026

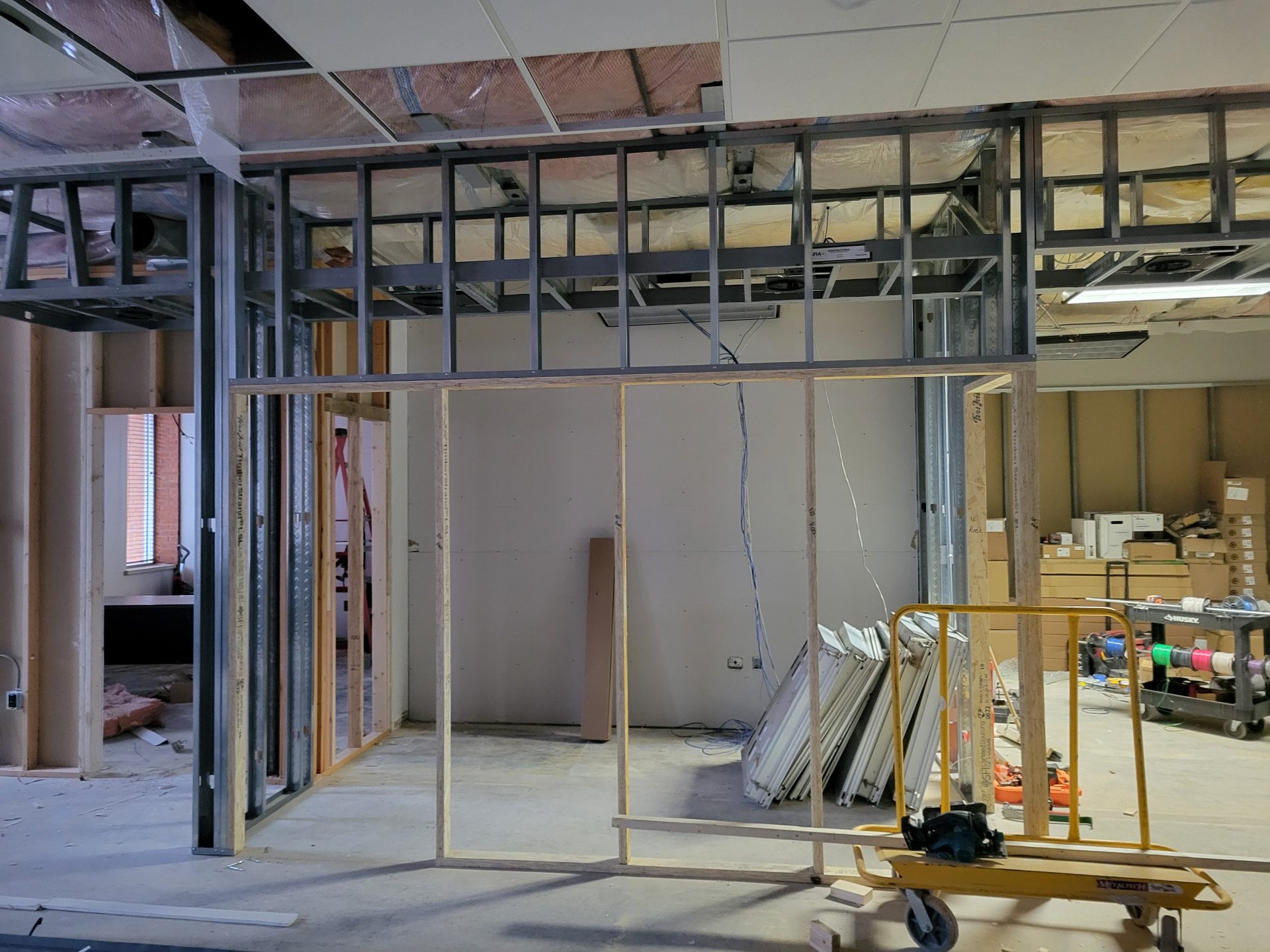

Frame for upstairs meeting room is in!

Image for timeline date 2/26/2026

Frame for wall by restrooms goes up!

Image for timeline date 2/25/2026

New windows being installed!

Image for timeline date 2/19/2026

Door to outdoor patio is in!

Image for timeline date 2/18/2026

Phase 2 demo is almost complete!

Image for timeline date 2/16/2026

Adult and Teen materials now located in Silver Creek meeting room in lower level!

Image for timeline date 1/29/2026

Posts get a little something extra!

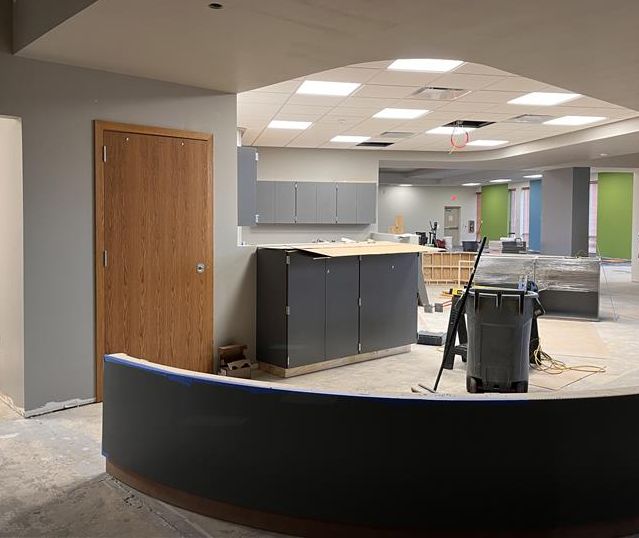

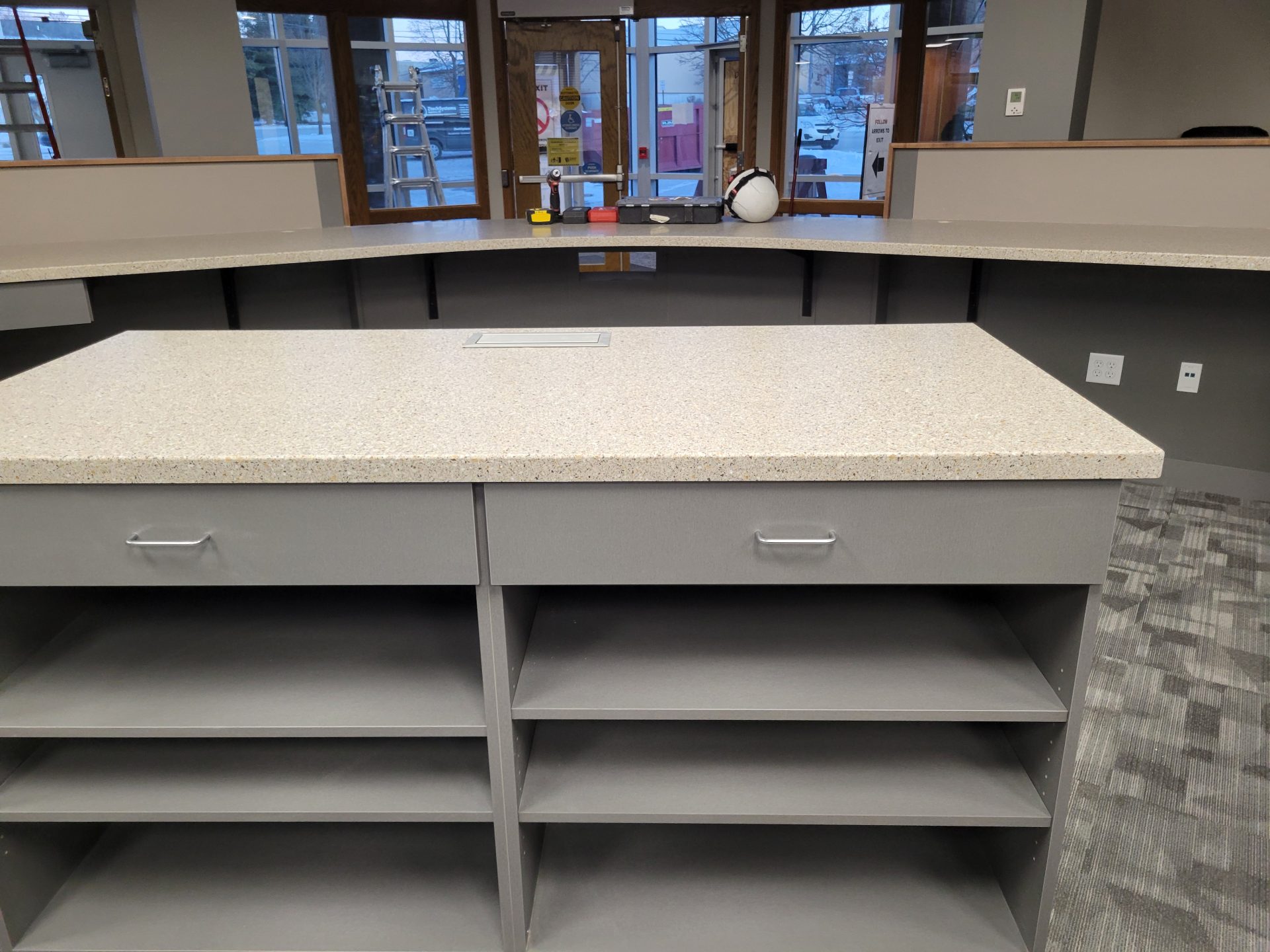

Image for timeline date 1/28/2026

New counter tops added!

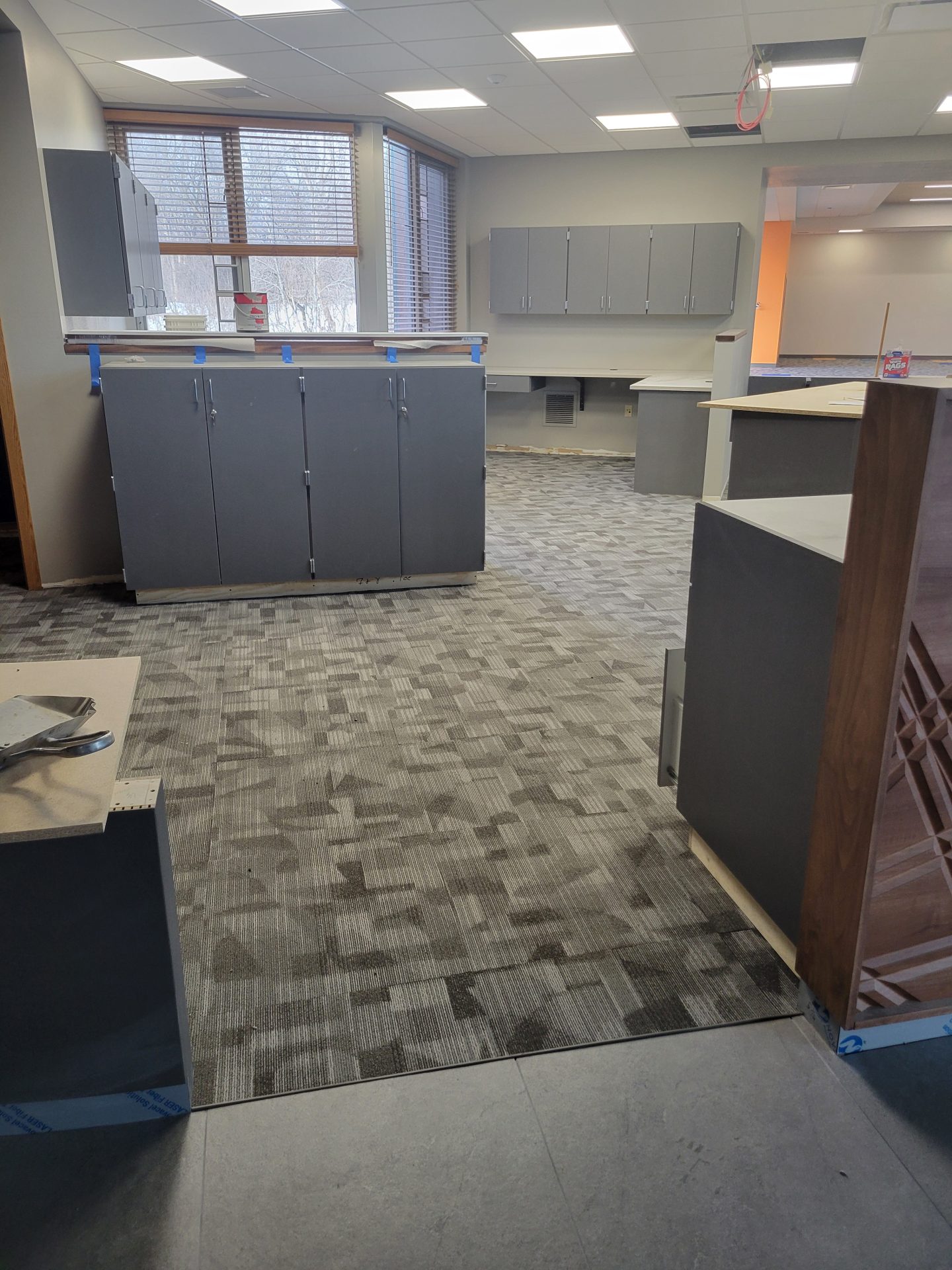

Image for timeline date 1/23/2026

Vestibule carpet is in!

Image for timeline date 1/22/2026

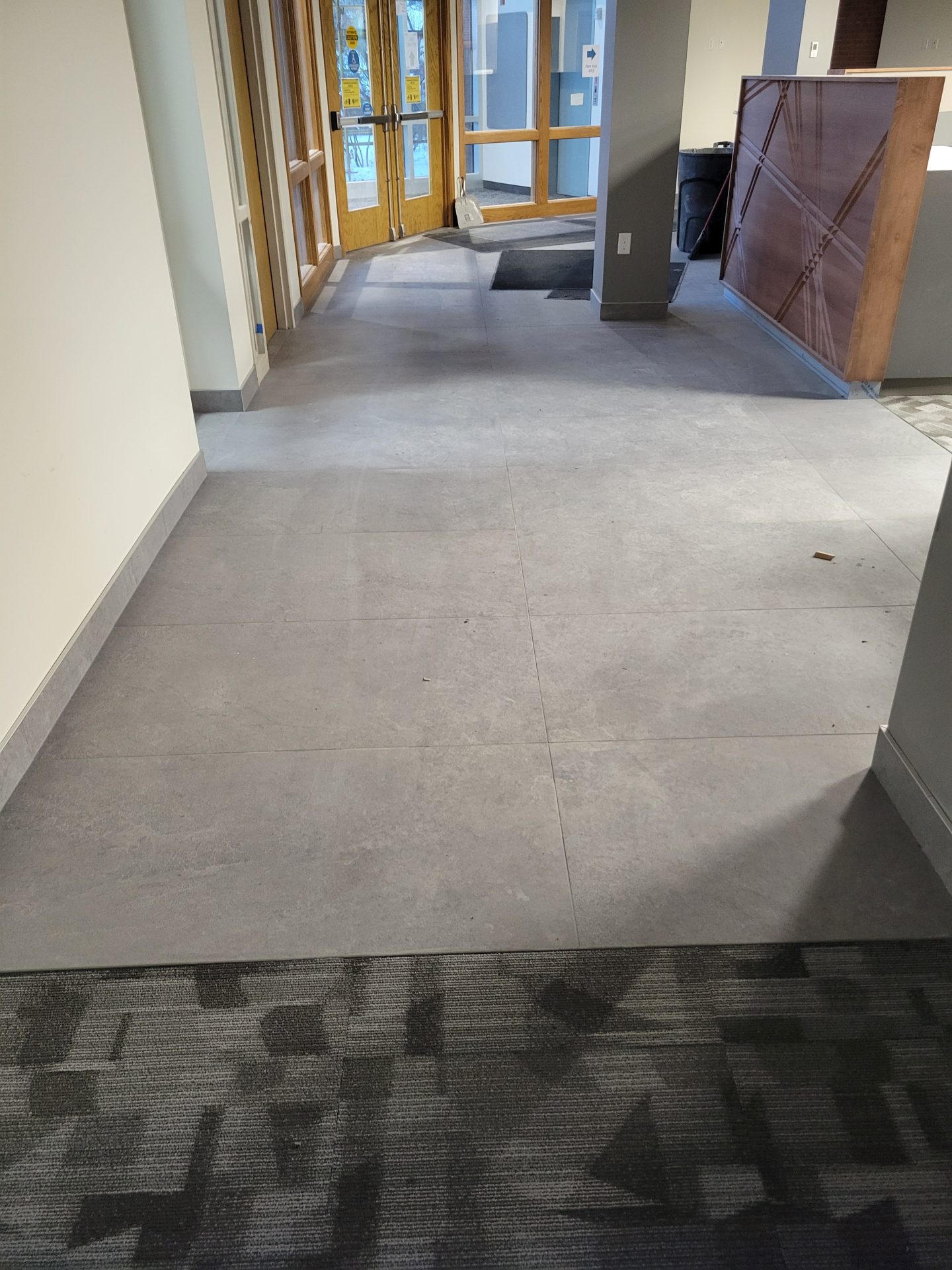

Tiling by the circulation desk is complete!

Image for timeline date 1/21/2026

Carpet is being installed!

Image for timeline date 1/7/2026

Children's department is coming along!

Image for timeline date 1/7/2026

New circulation desk is starting to take shape!

Image for timeline date 1/7/2026

Staff workstations and storage installations are in progress

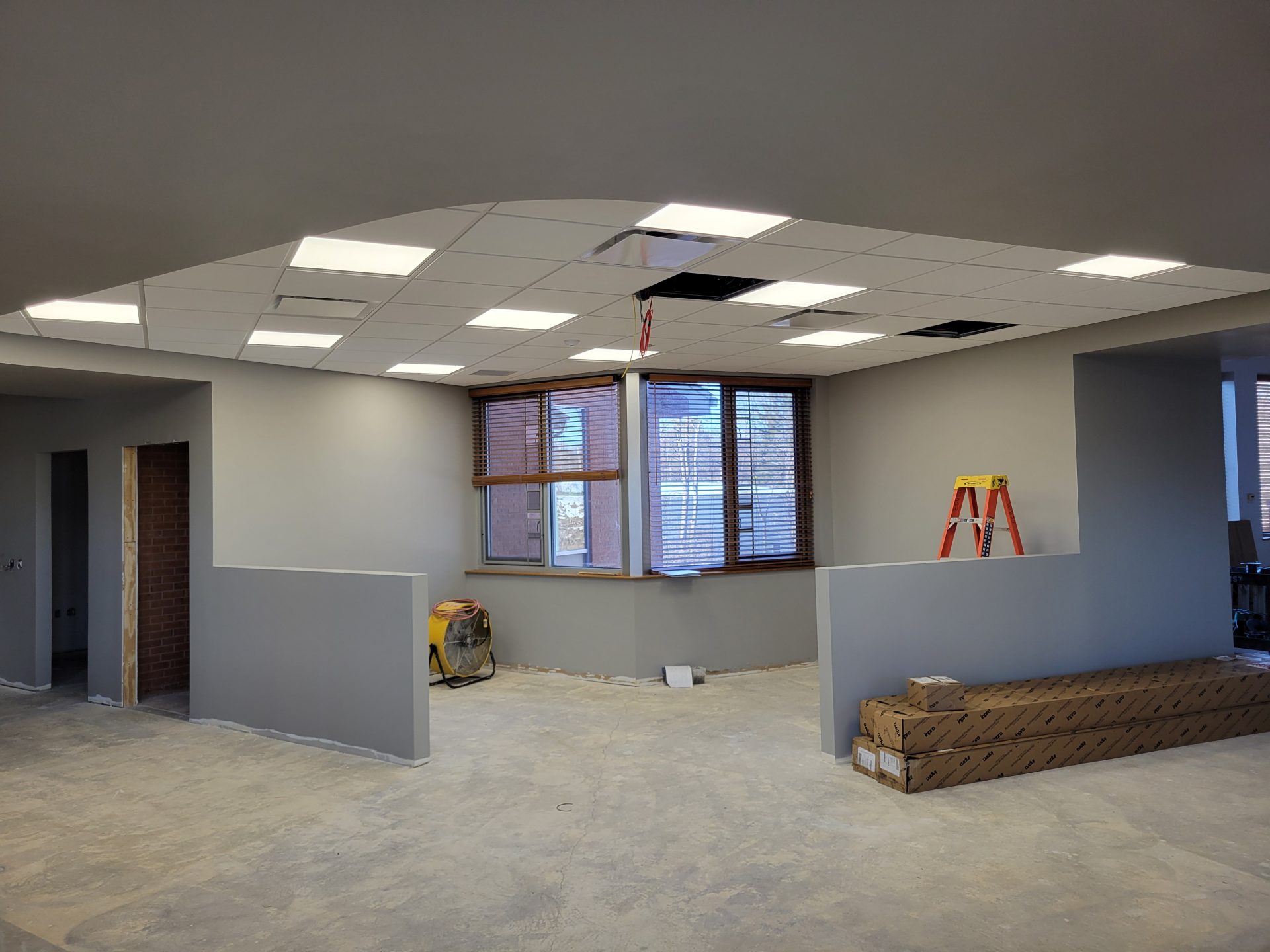

Image for timeline date 12/19/2025

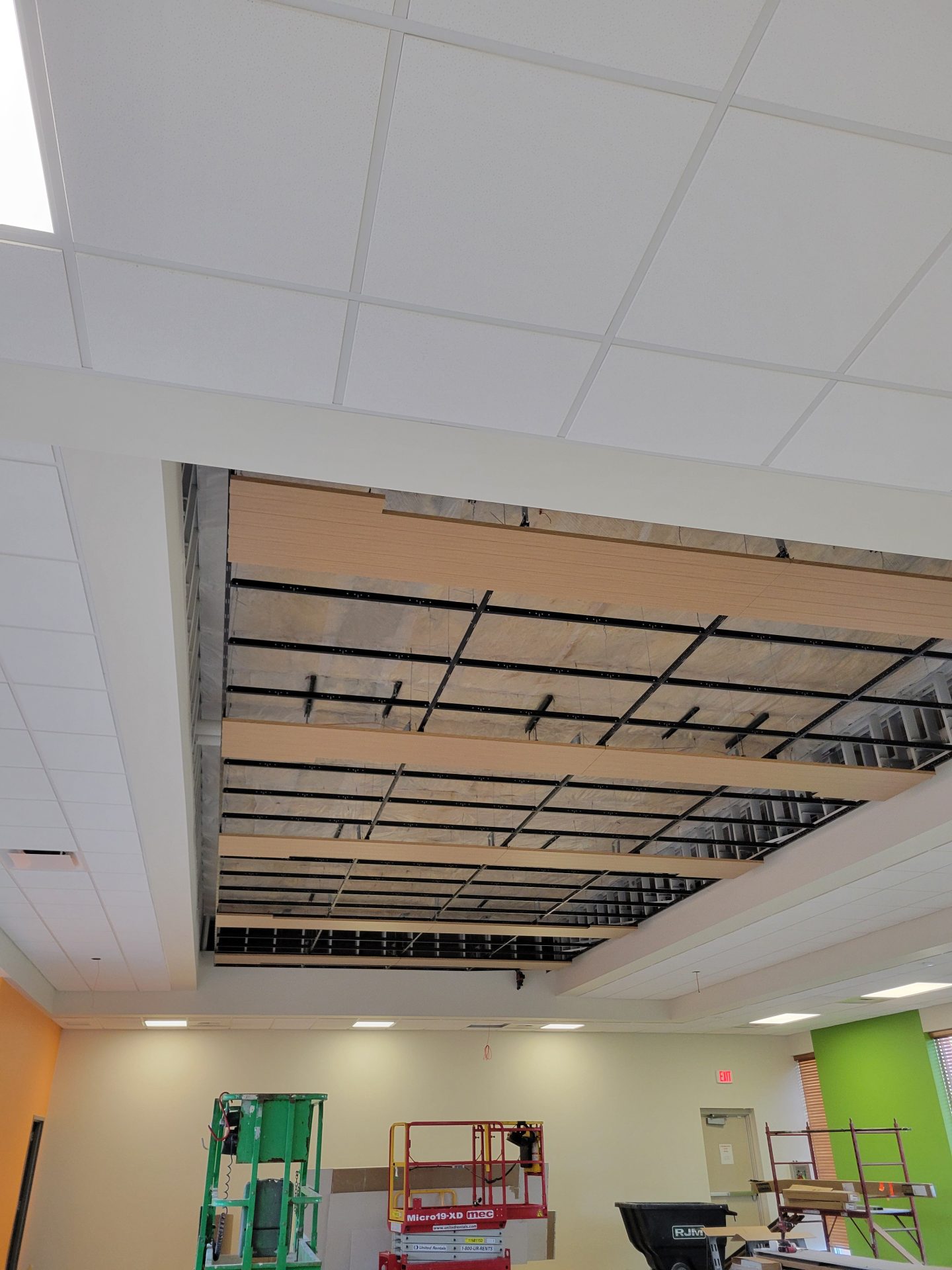

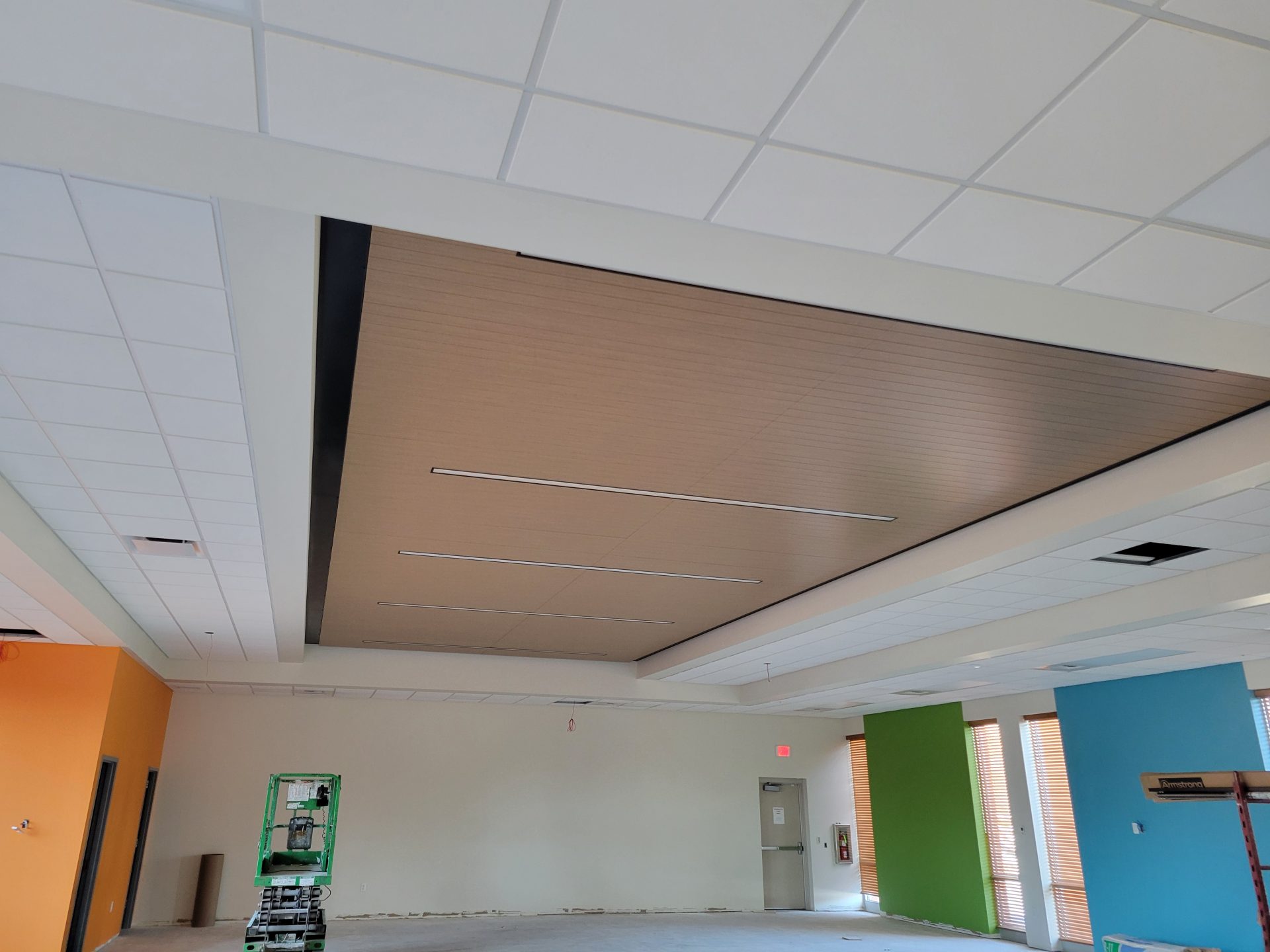

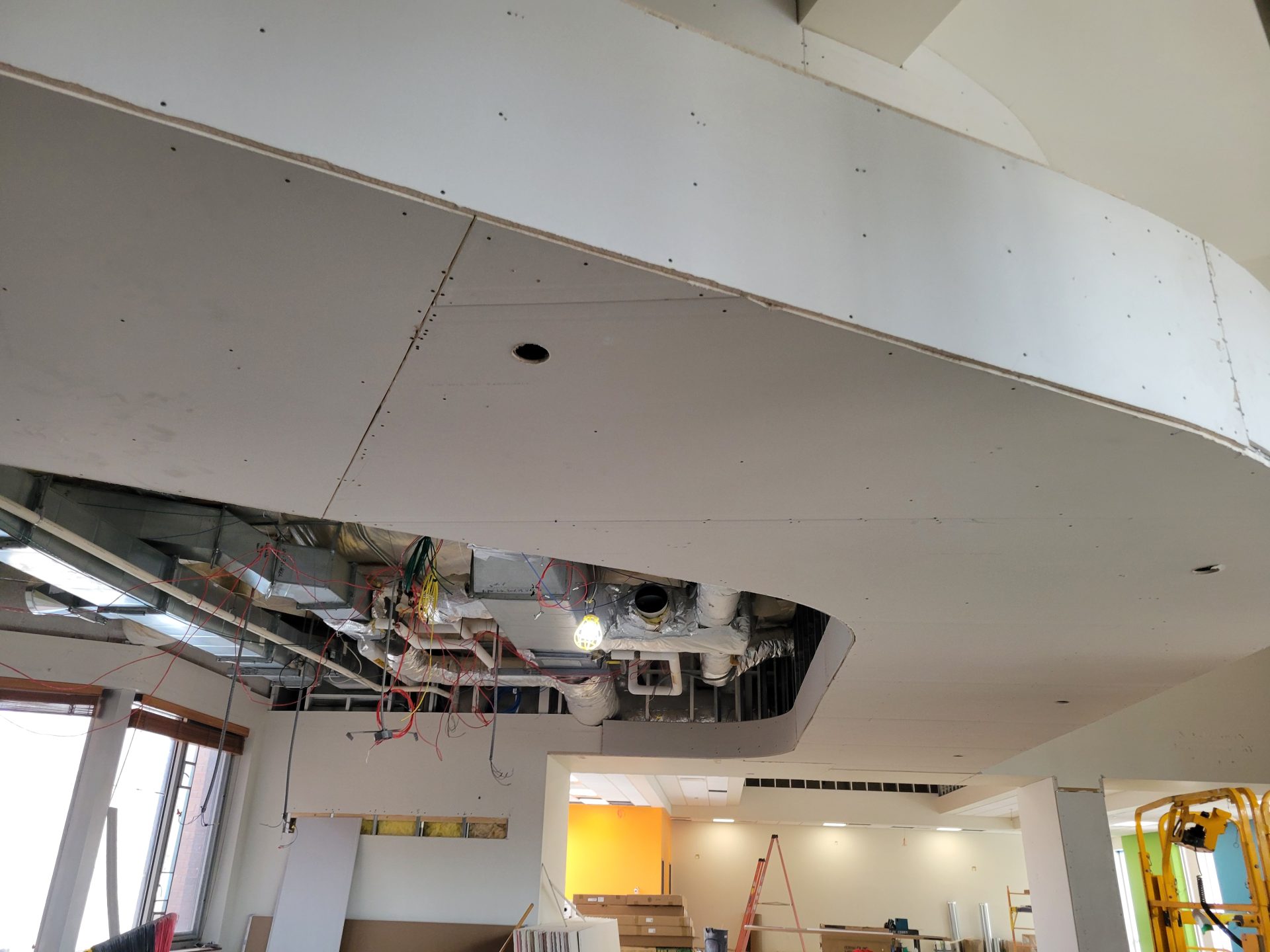

Ceiling is finished!

Image for timeline date 12/17/2025

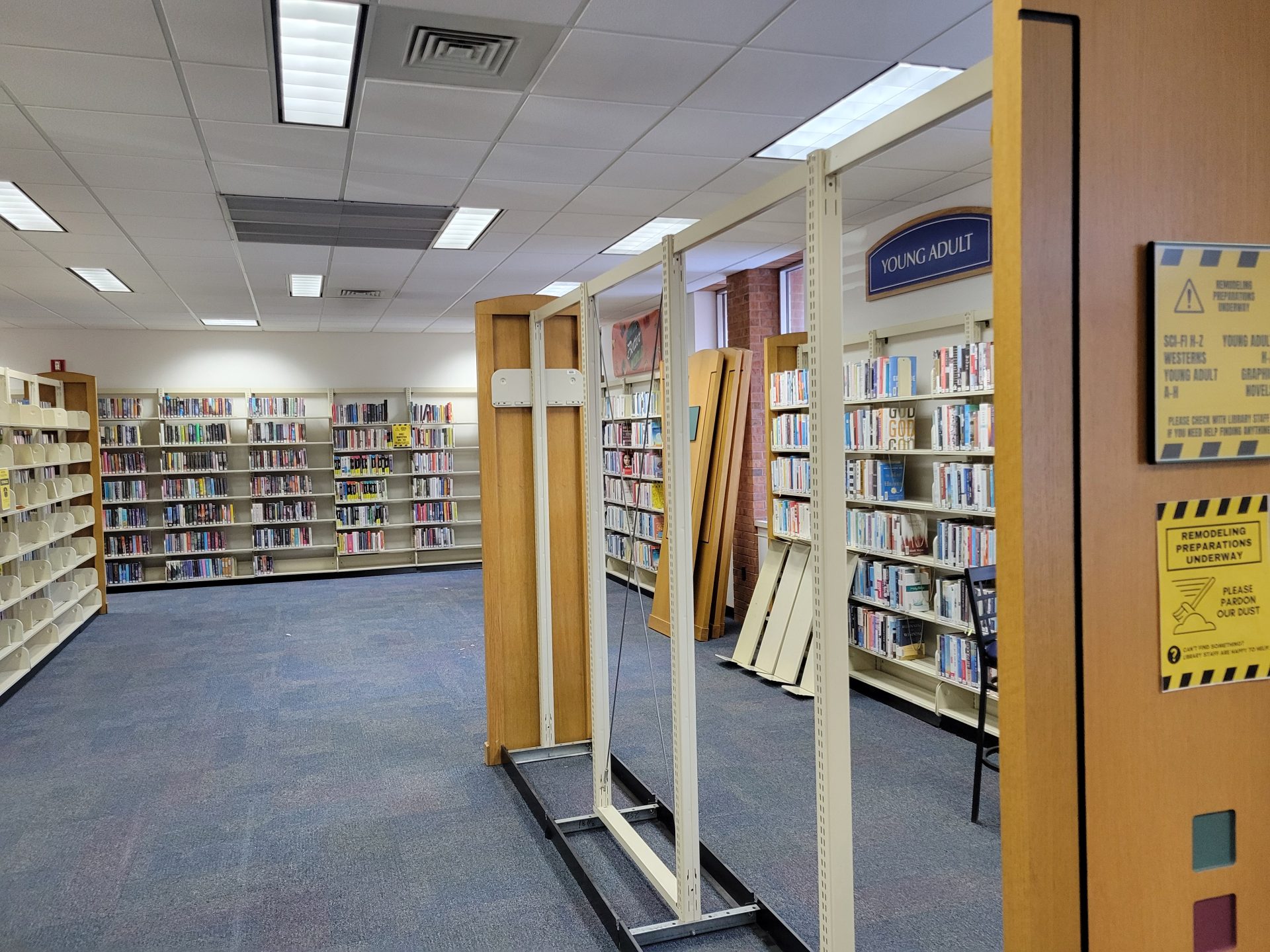

Ceiling in Children's Department is going in!

Image for timeline date 12/16/2025

Books are moving to storage and shelving is getting moved!

Image for timeline date 12/14/2025

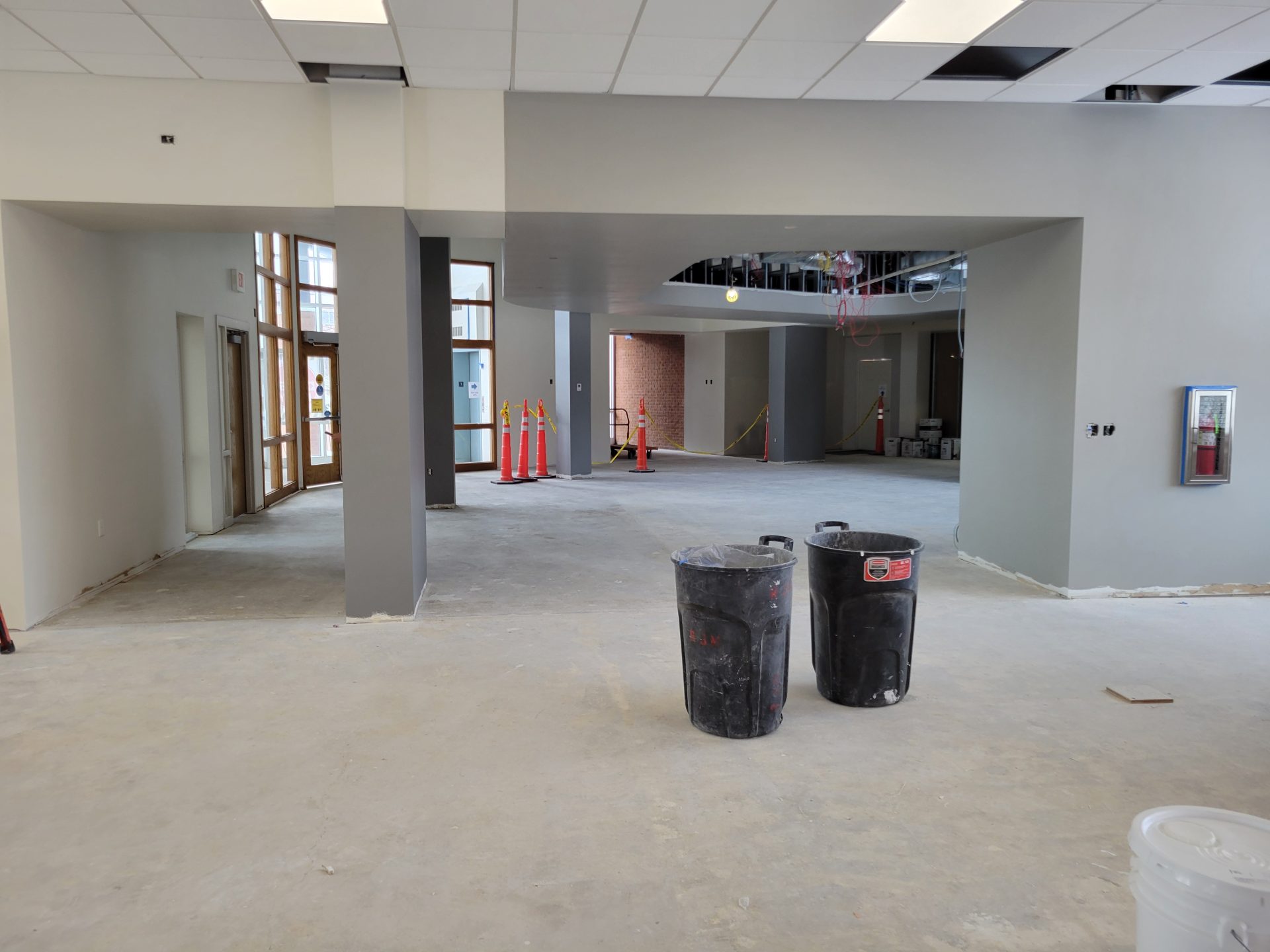

Partial walls are done and lighting is mostly in!

Image for timeline date 12/9/2025

Partial walls go up in Circulation area!

Image for timeline date 12/8/2025

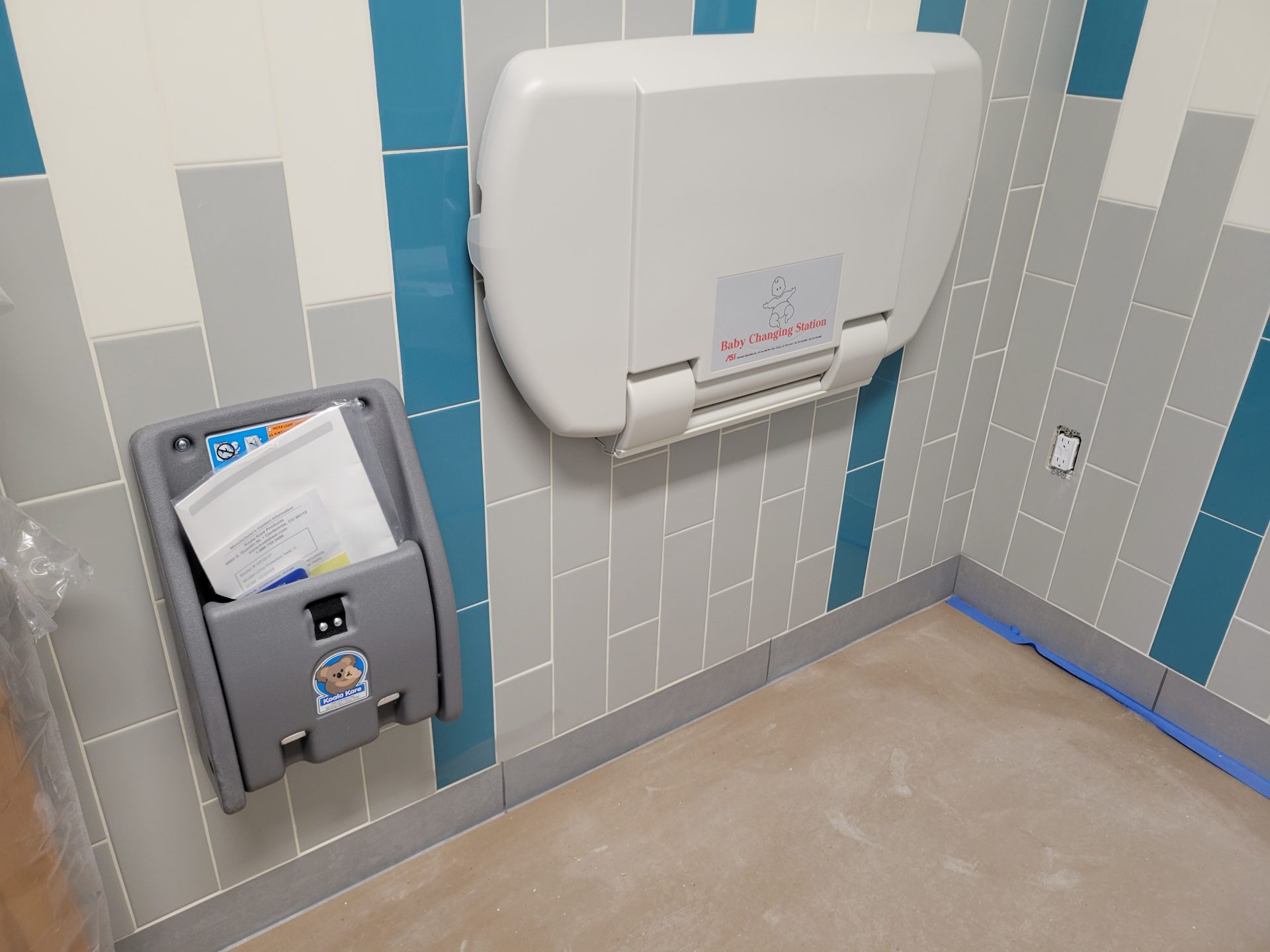

Family bathroom additions!

Image for timeline date 12/5/2025

Collections are moving into storage!

Image for timeline date 12/4/2025

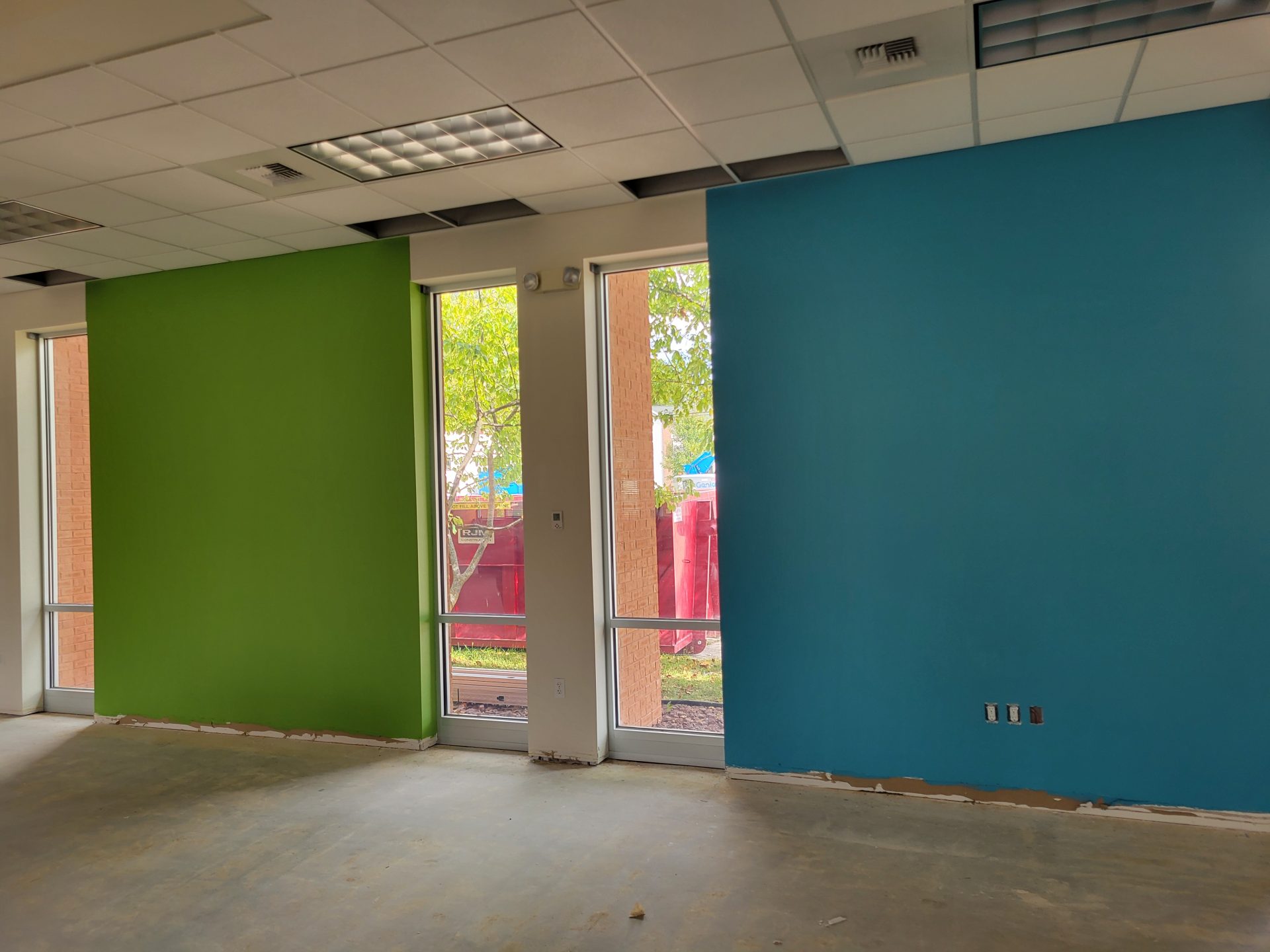

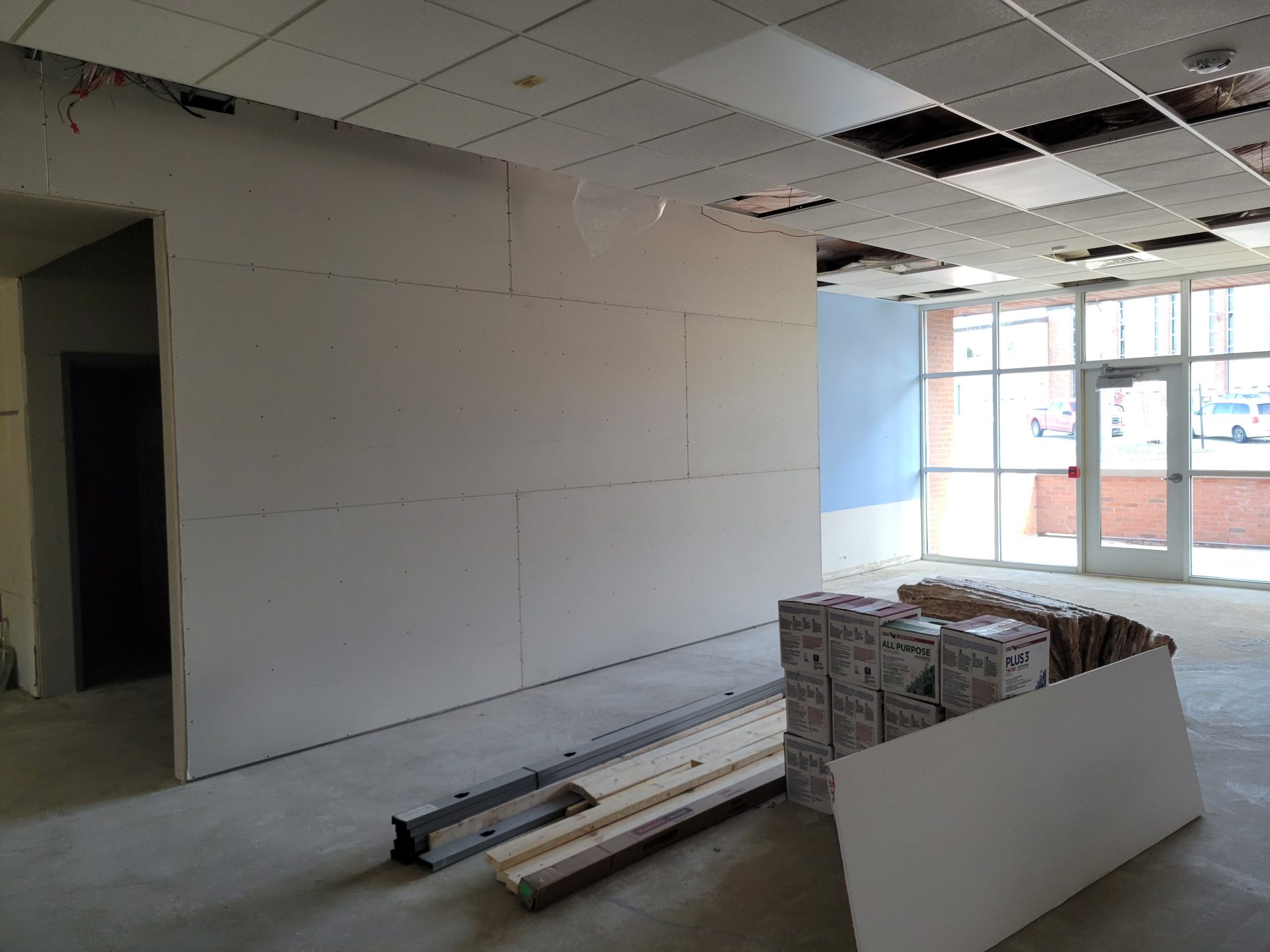

Drywall is mostly finished and painting has begun!

Image for timeline date 12/3/2025

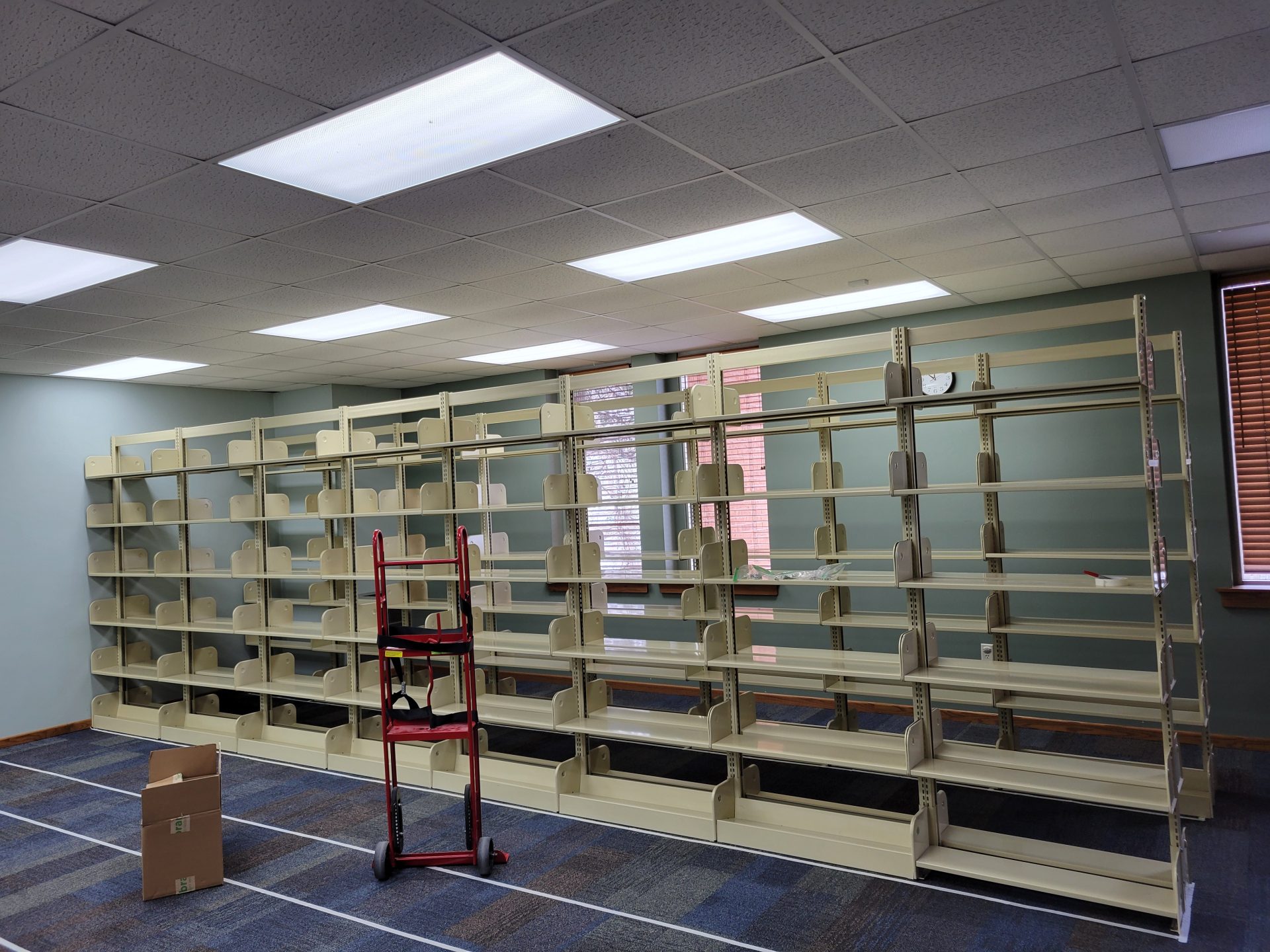

Shelving is built for putting collections into storage!

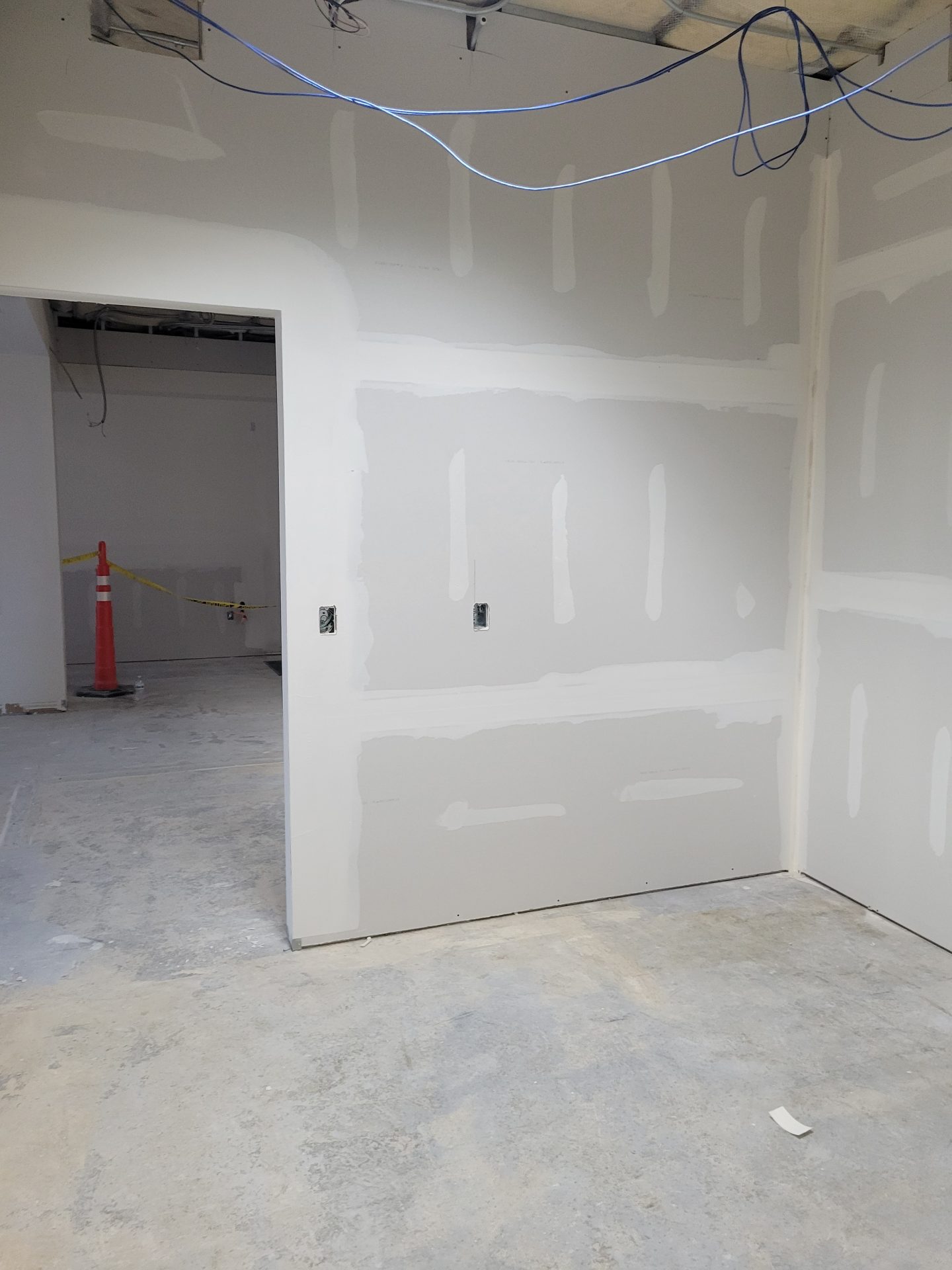

Image for timeline date 11/21/2025

Walls are taped and covered!

Image for timeline date 11/20/2025

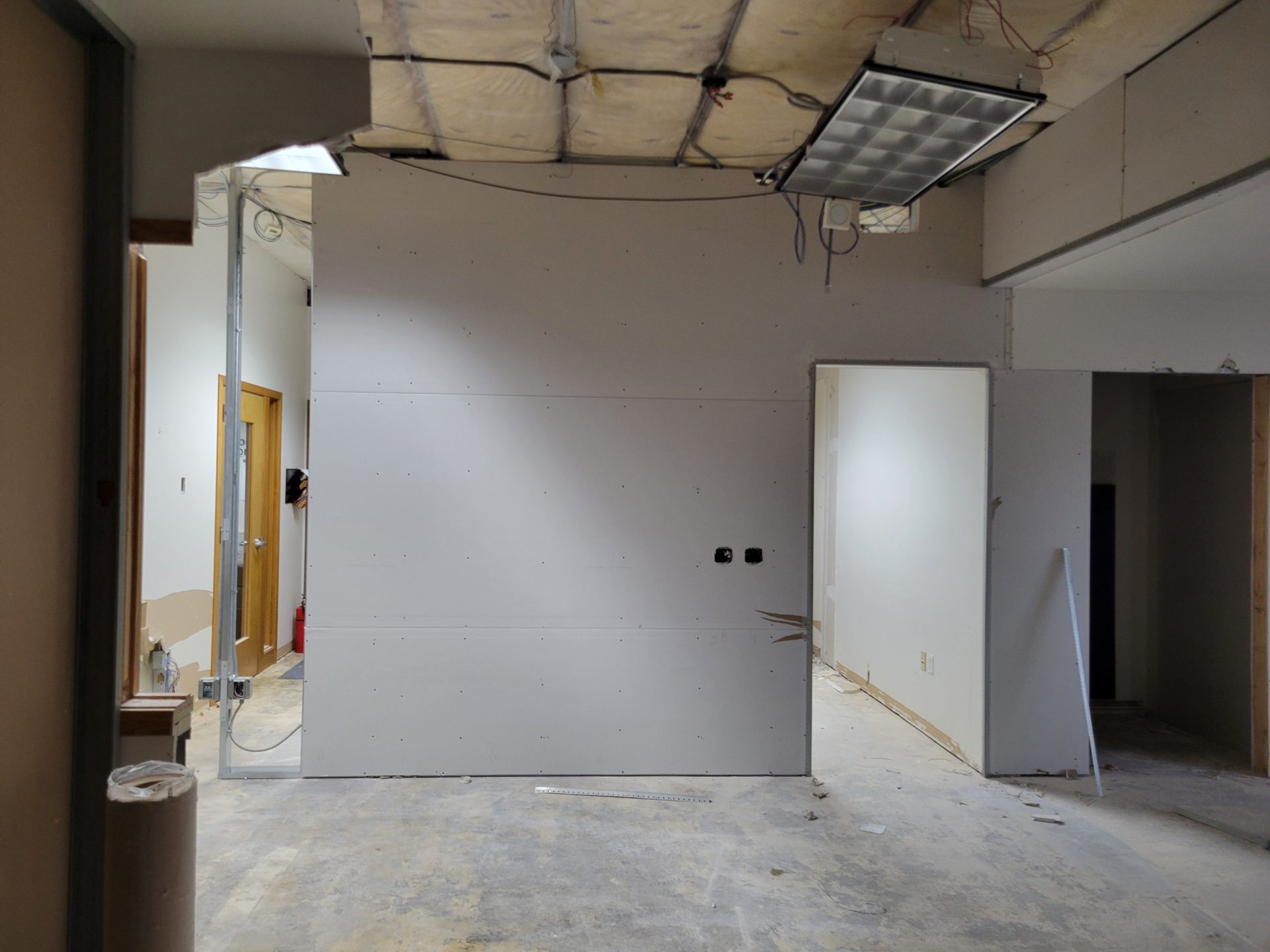

Drywall is going up!

Image for timeline date 11/19/2025

Drywall added to the Circulation desk area!

Image for timeline date 11/17/2025

Cap added to patio wall!

Image for timeline date 10/24/2025

Outdoor sidewalk is finished and ground is getting landscaped!

Image for timeline date 10/23/2025

New Friends of the Library room is being prepared!

Image for timeline date 10/23/2025

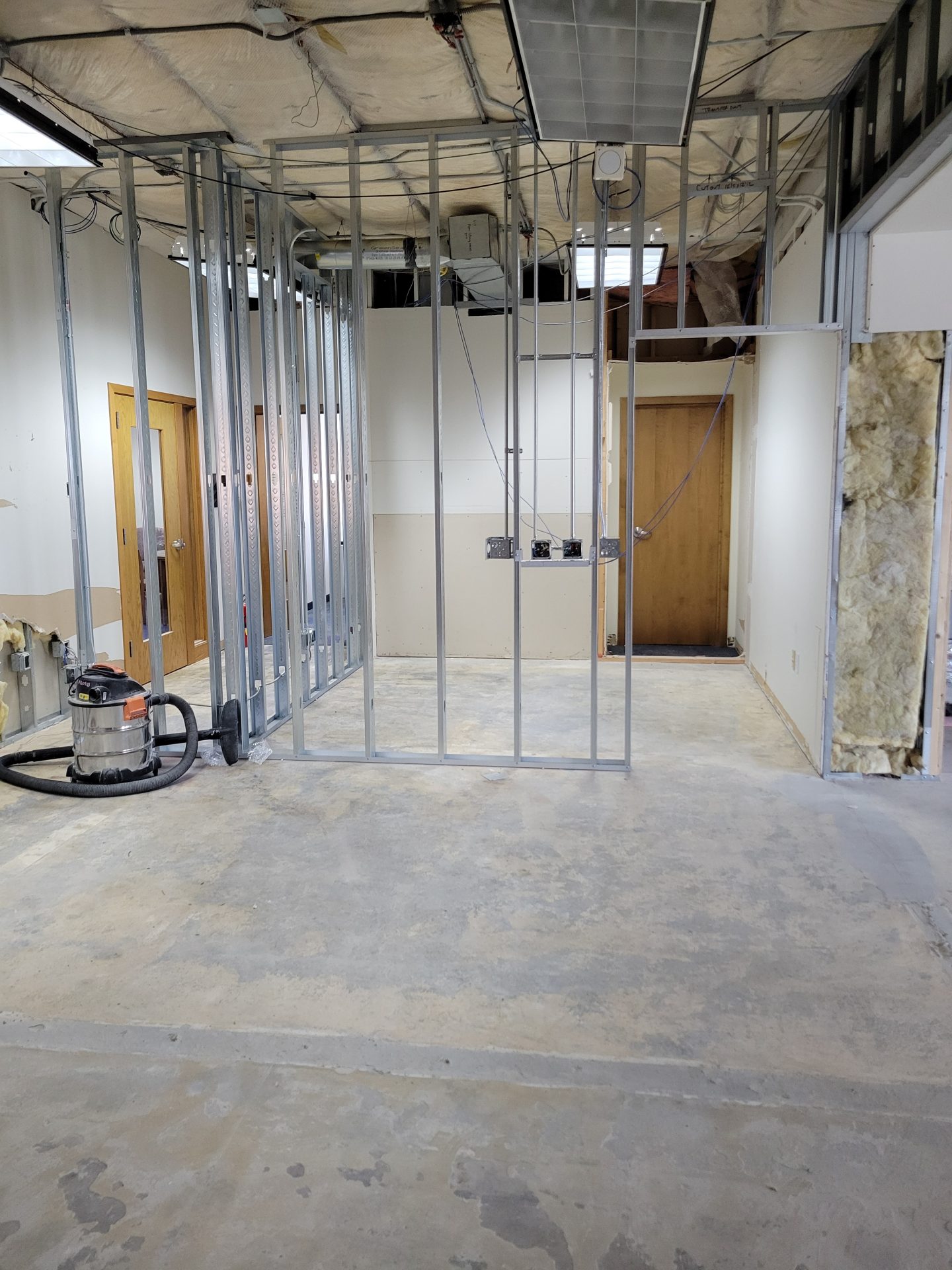

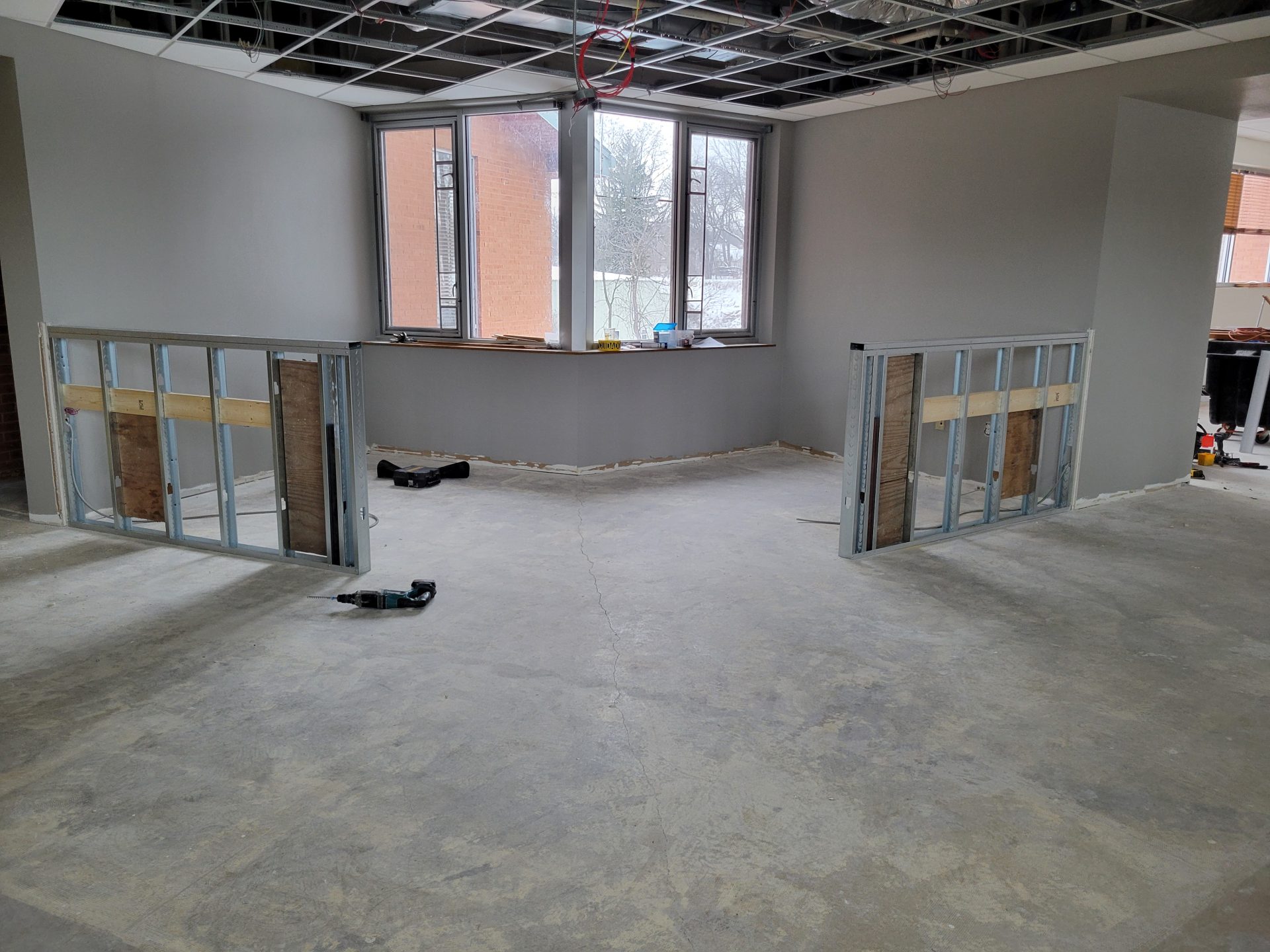

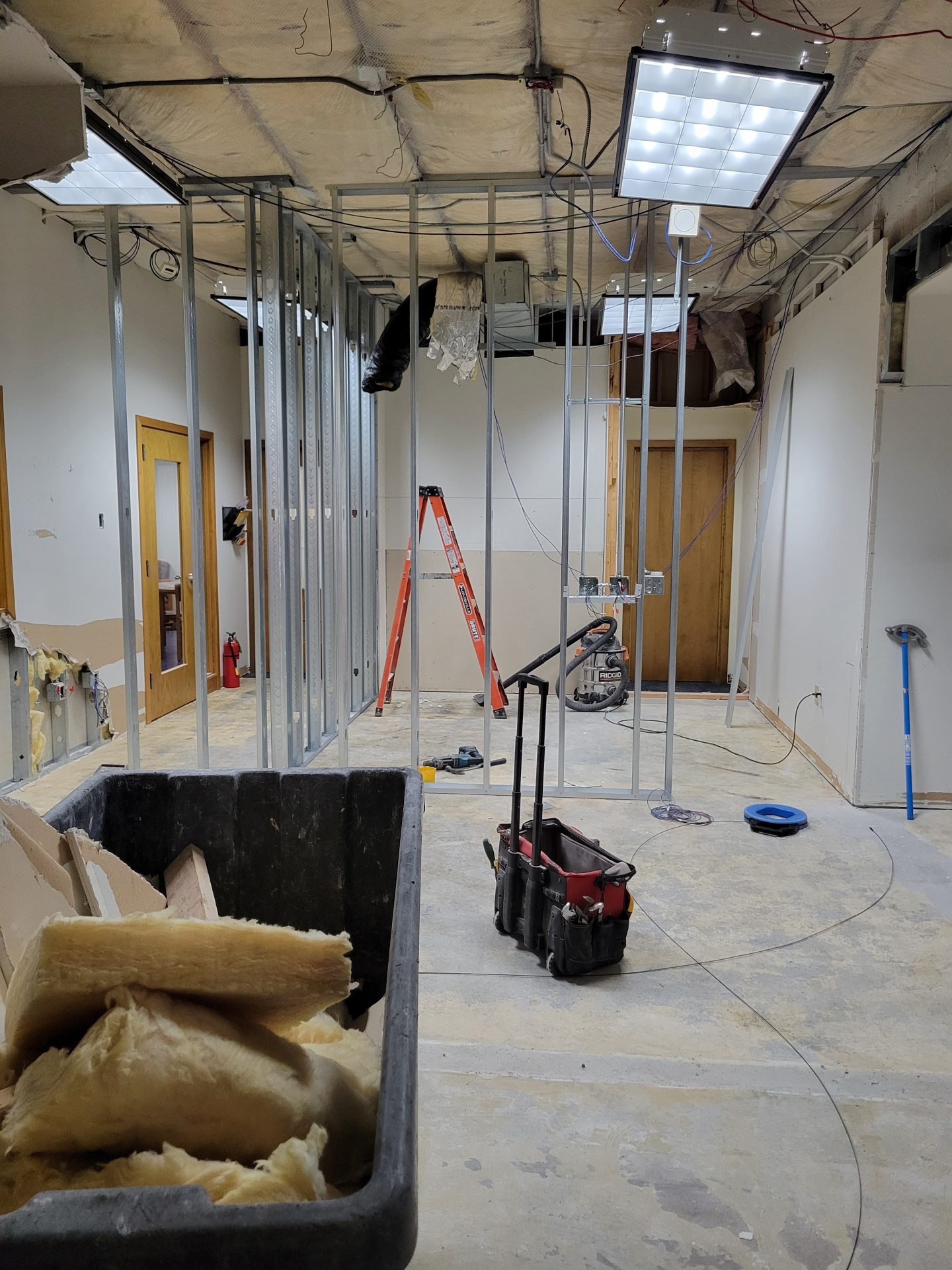

Framework is in for staff office and new small meeting room!

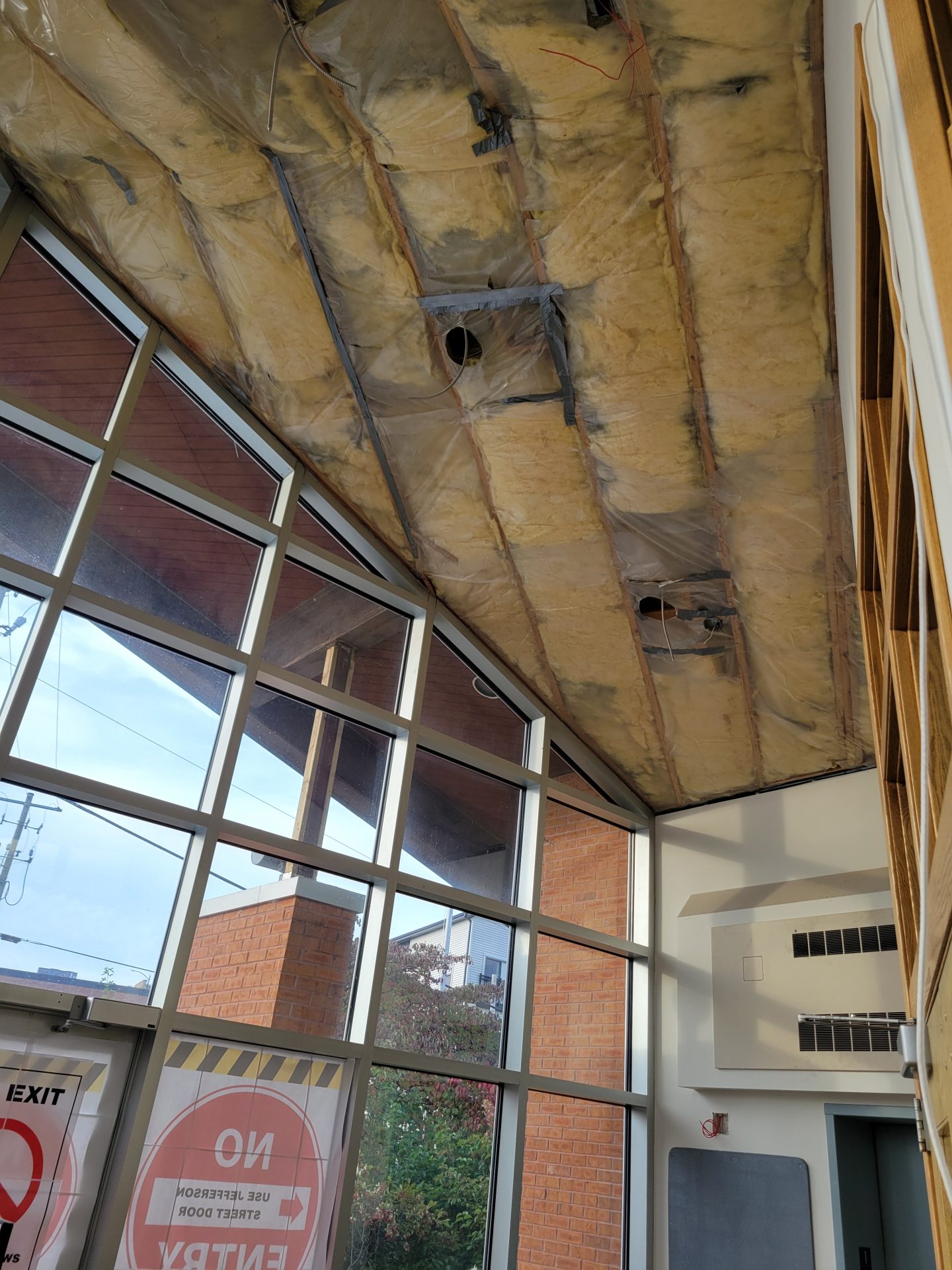

Image for timeline date 10/17/2025

Work in the vestibule continues!

Image for timeline date 10/17/2025

Entryway sidewalk and paving almost done!

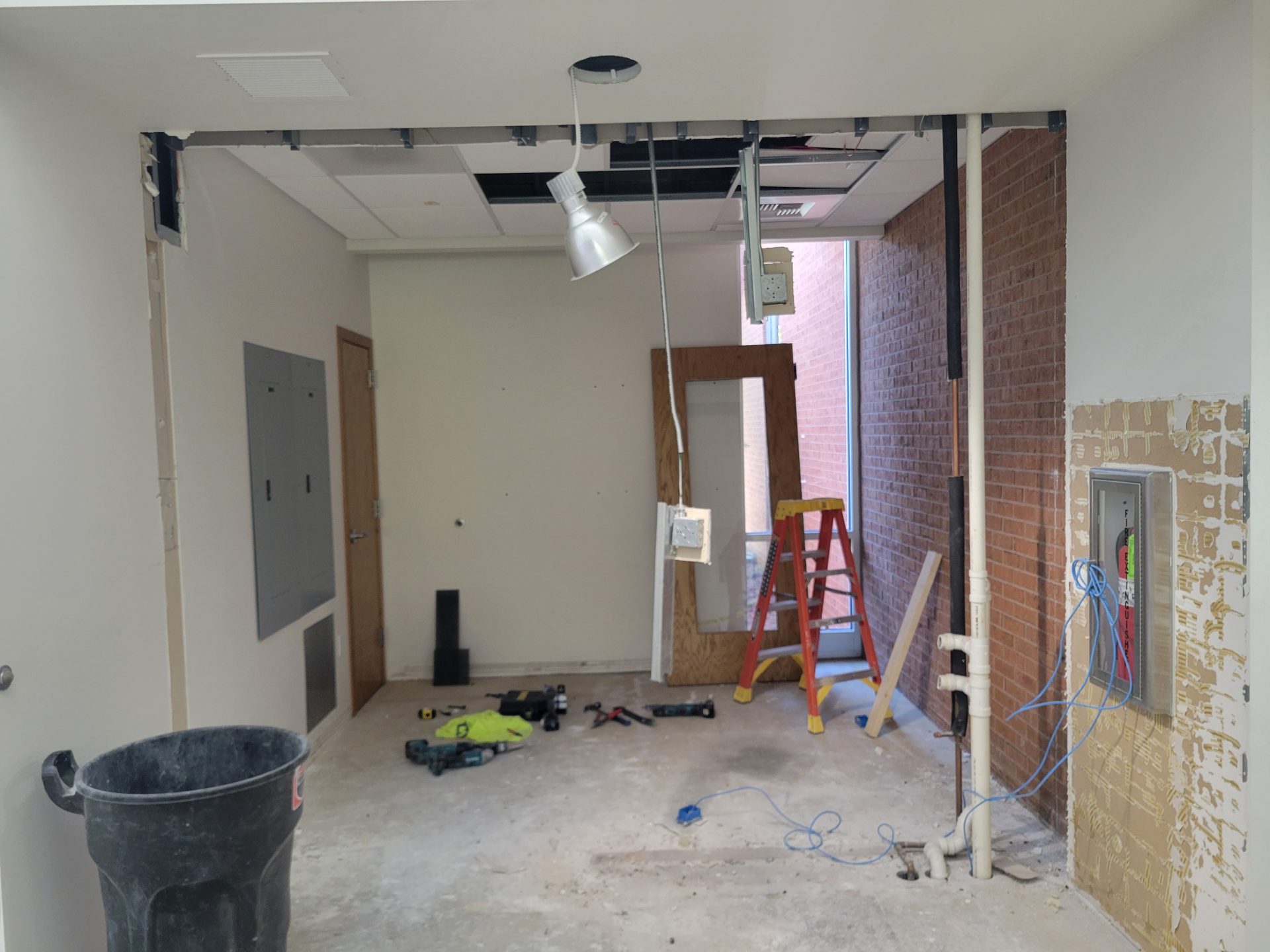

Image for timeline date 10/13/2025

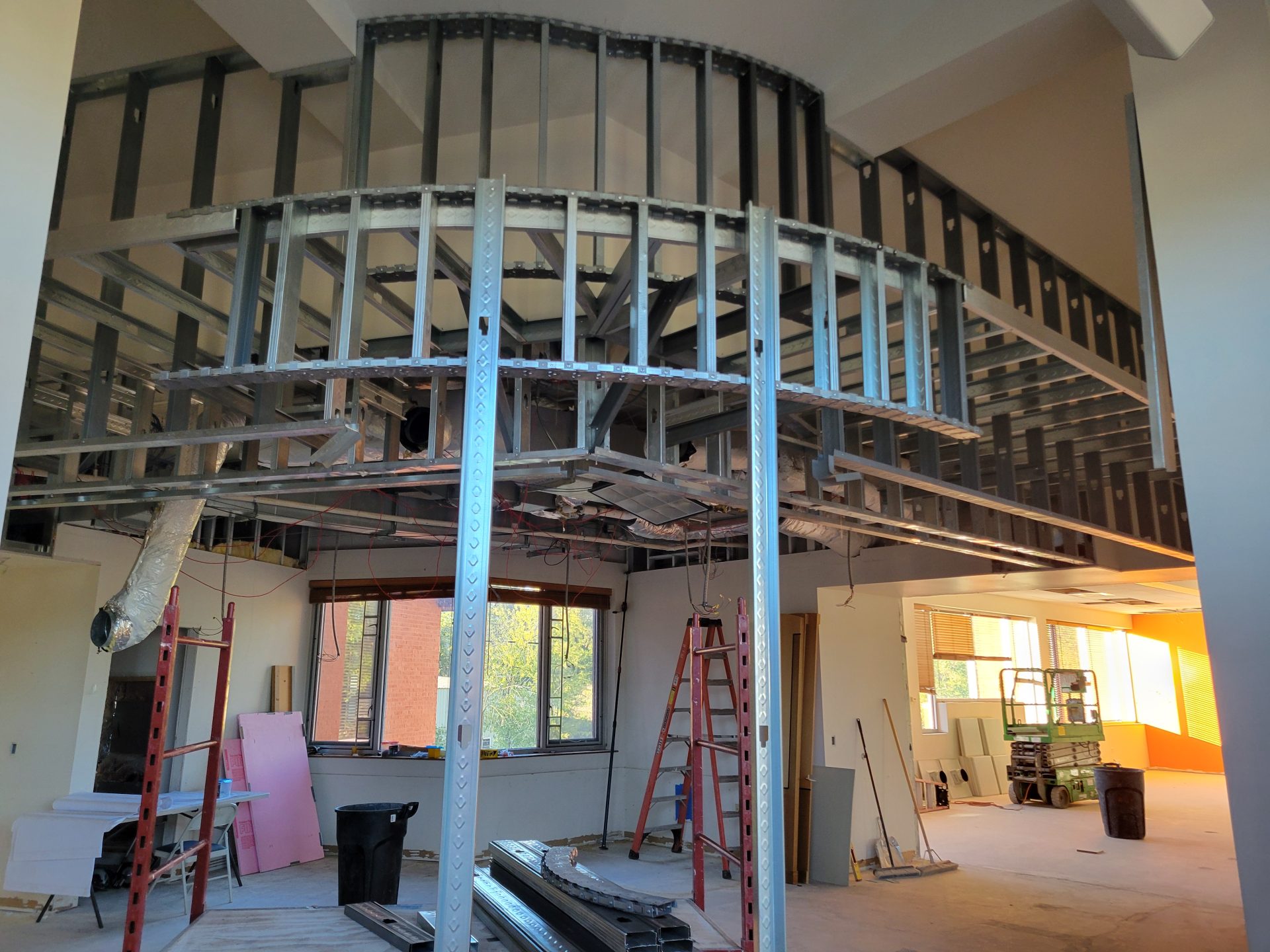

Rough-ins for Circulation Supervisor office area begins!

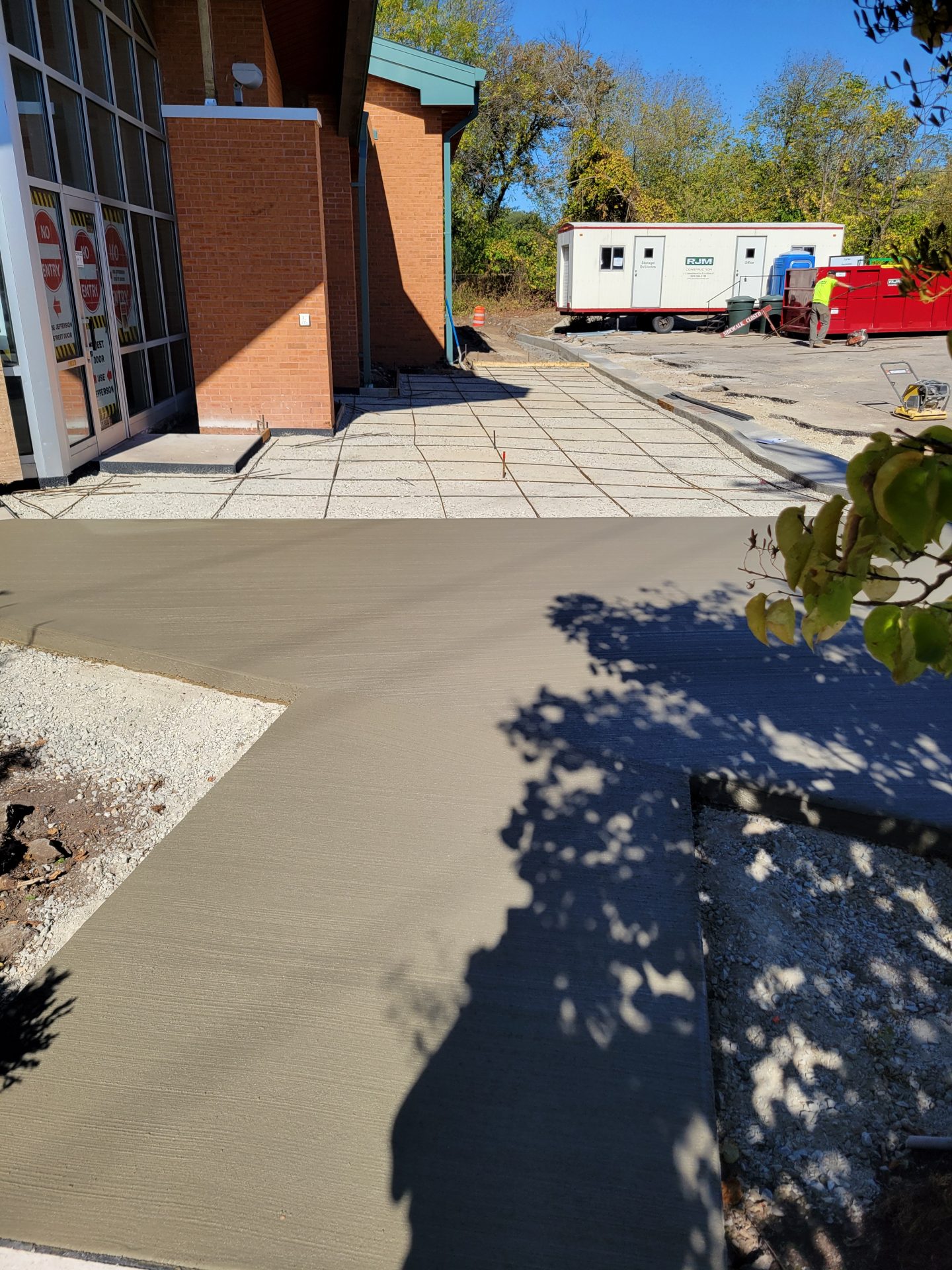

Image for timeline date 10/9/2025

Concrete for new walkway by entrance is poured!

Image for timeline date 10/9/2025

New sidewalk is poured by front entrance!

Image for timeline date 10/9/2025

Work on the new Circulation Desk area is ongoing!

Image for timeline date 10/7/2025

The old copier room will become the Friends of the Library book sale room!

Image for timeline date 10/6/2025

Getting ready for the new curb and sidewalk at the front of the library!

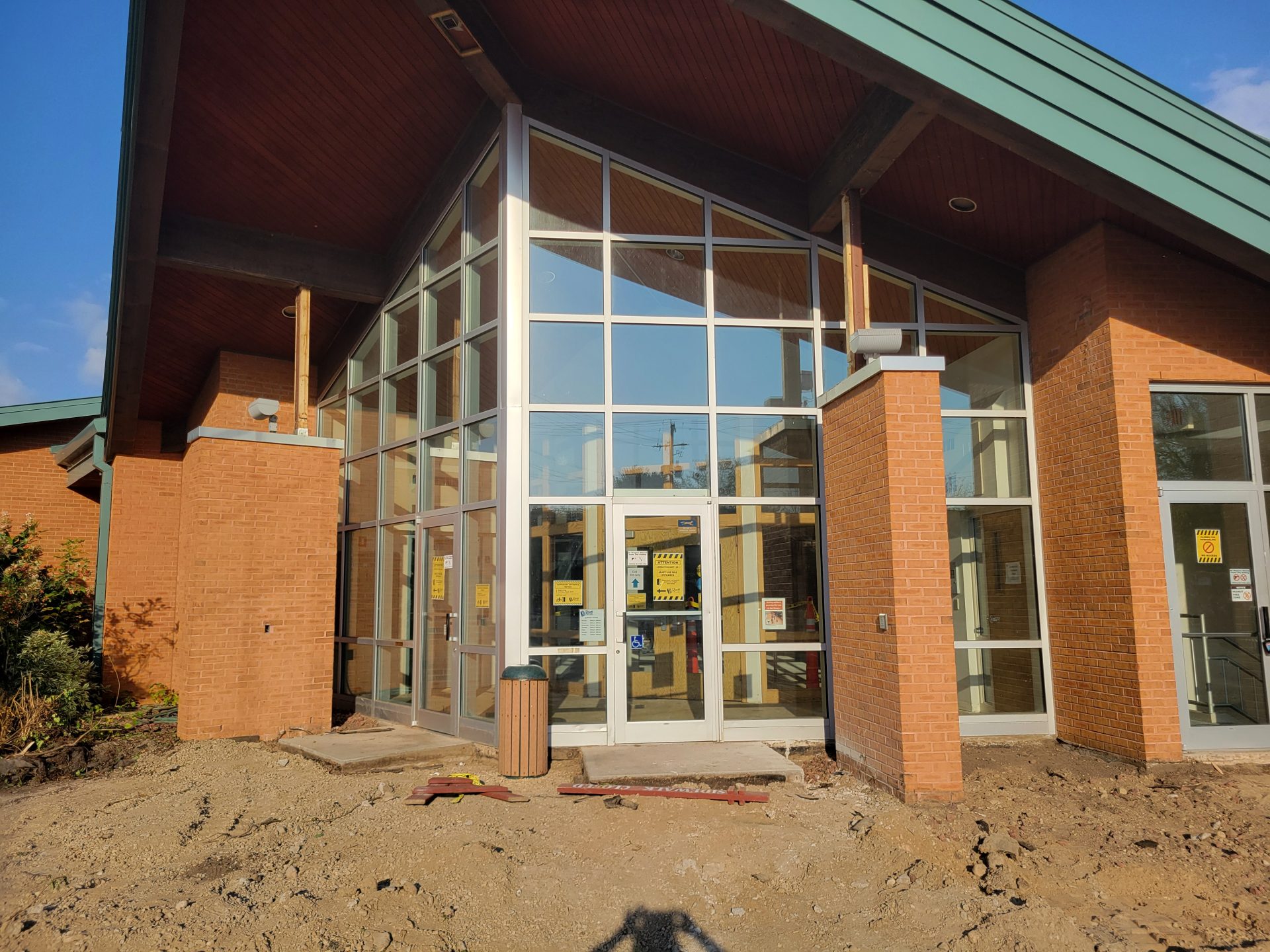

Image for timeline date 10/3/025

Entryway is getting ready for new curbs and sidwalk!

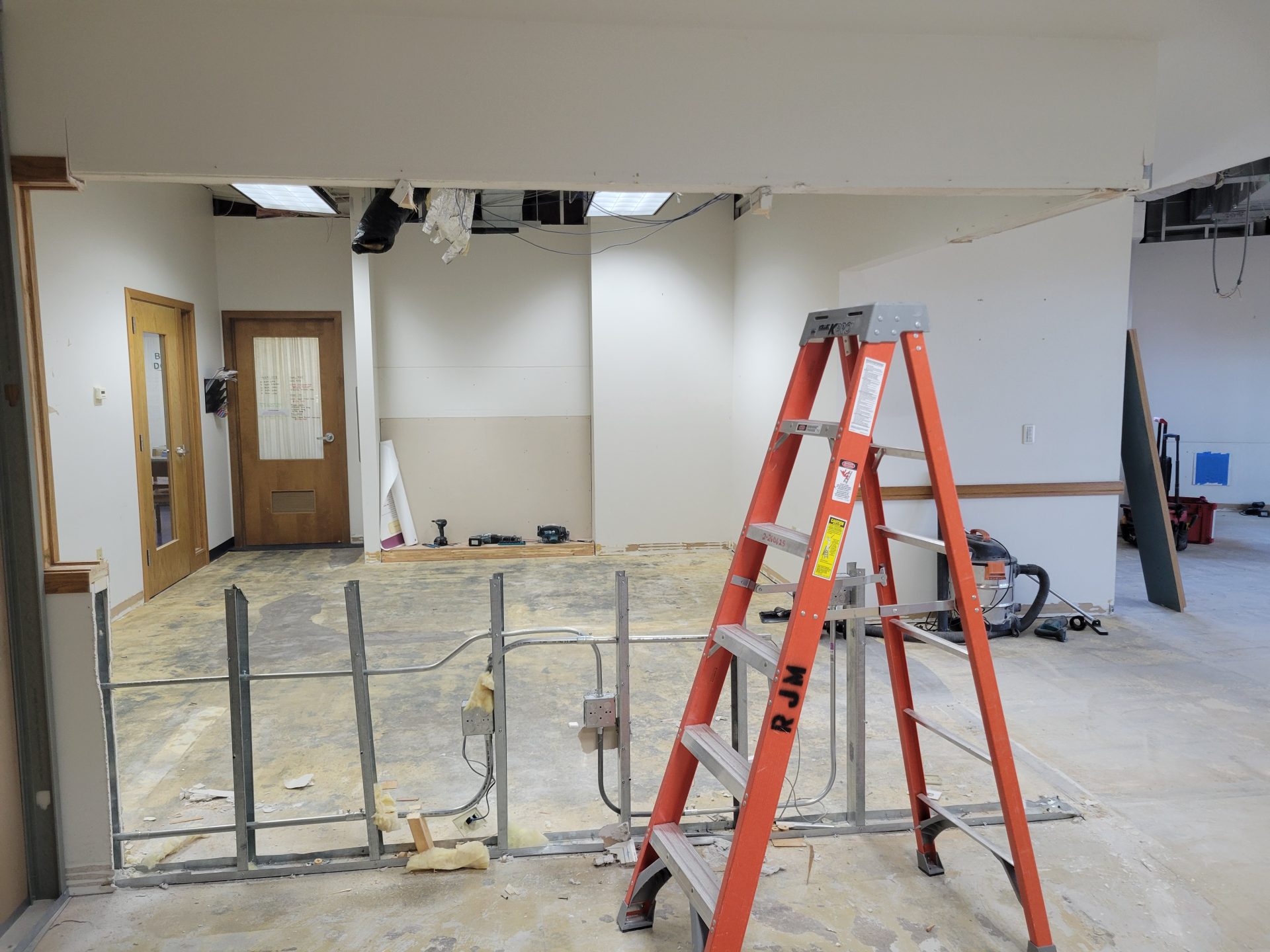

Image for timeline date 10/2/2025

Circulation area is emptied out!

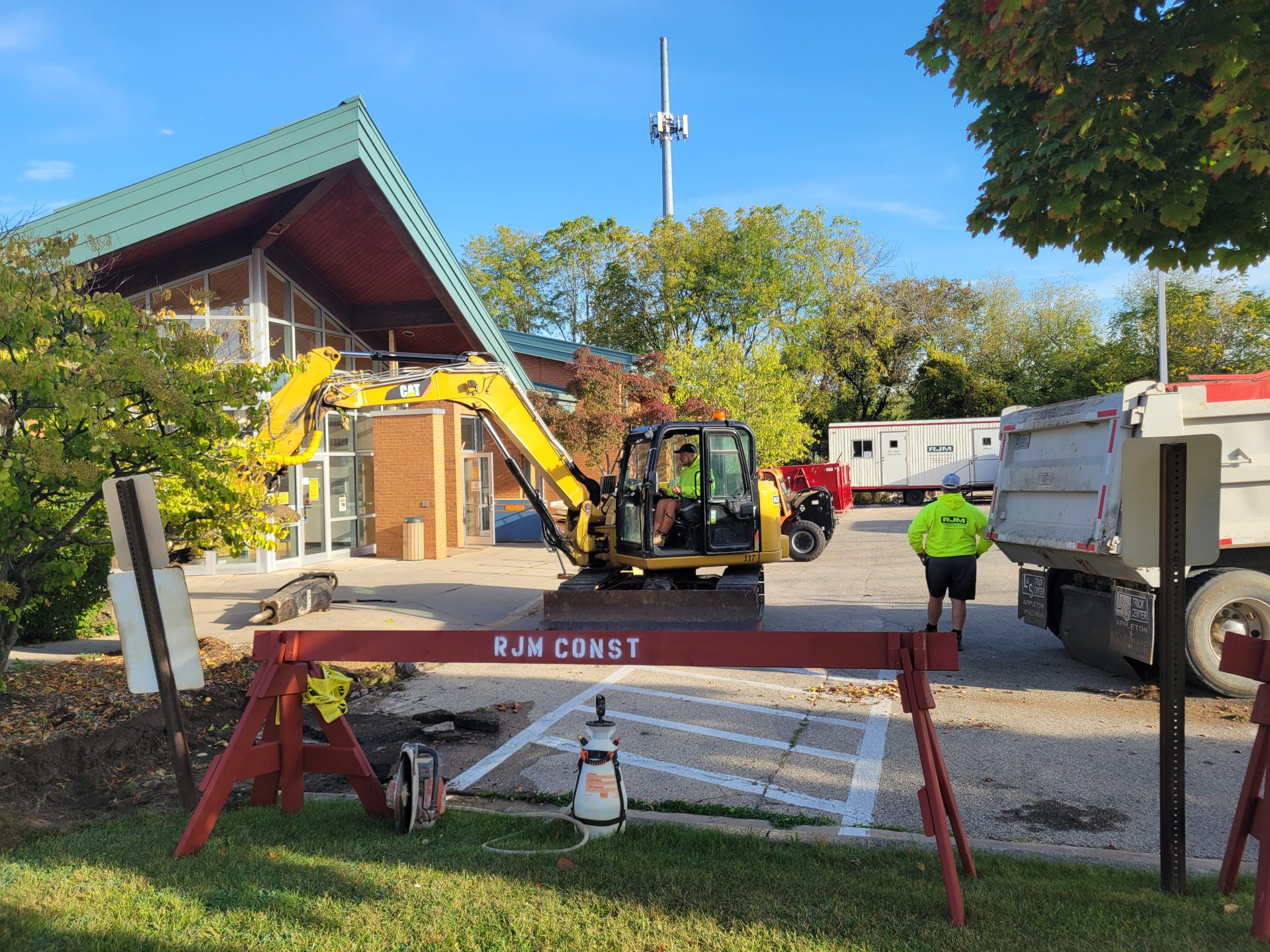

Image for timeline date 10/1/2025

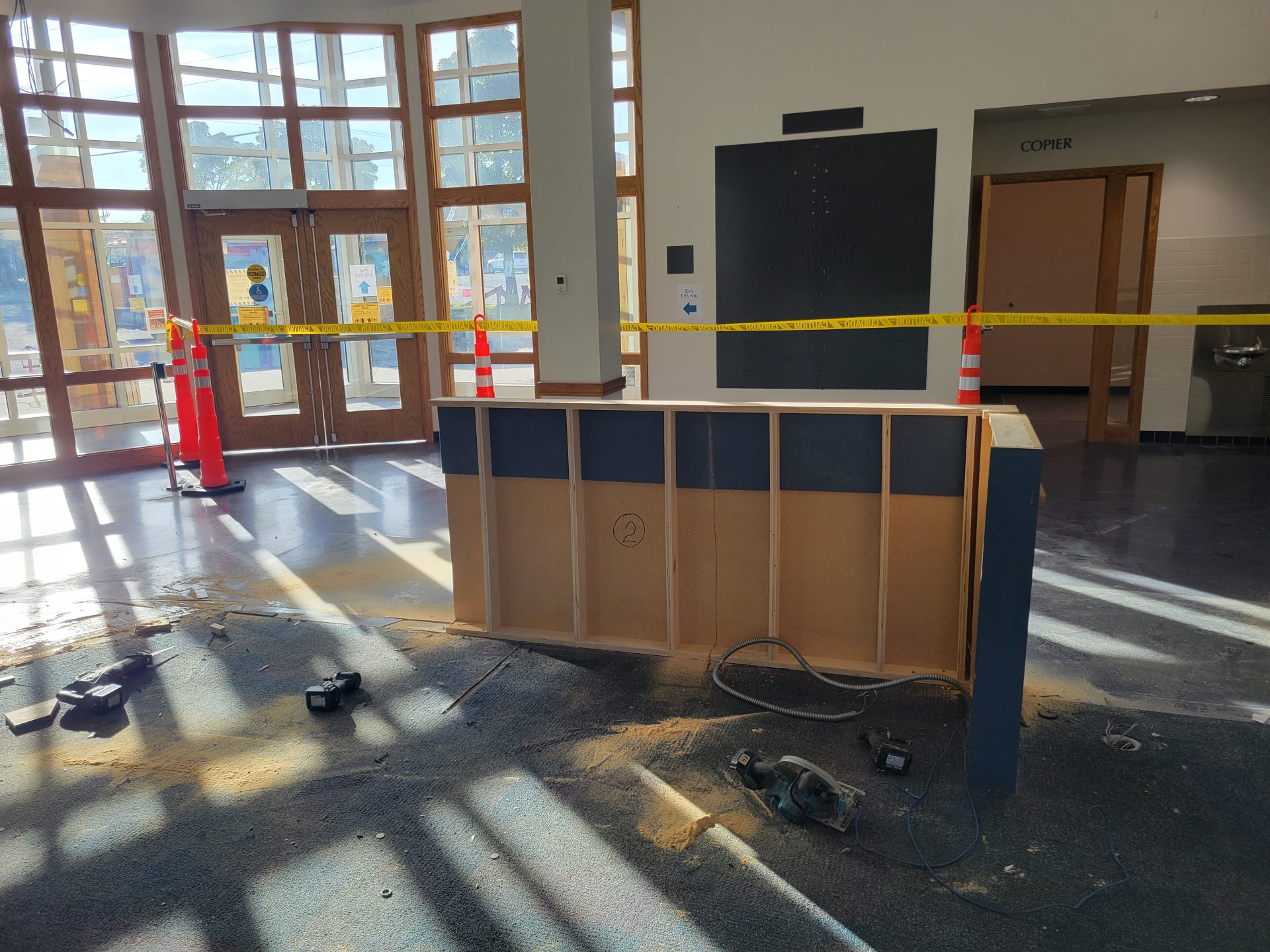

Circulation desk is taken down!

Image for timeline date 10/1/2025

Front sidewalk is ripped up!

Image for timeline date 9/30/2025

Wooden baffles removed from entryway!

Image for timeline date 9/29/2025

Temporary circulation desk is now up and running!

Image for timeline date 9/25/2025

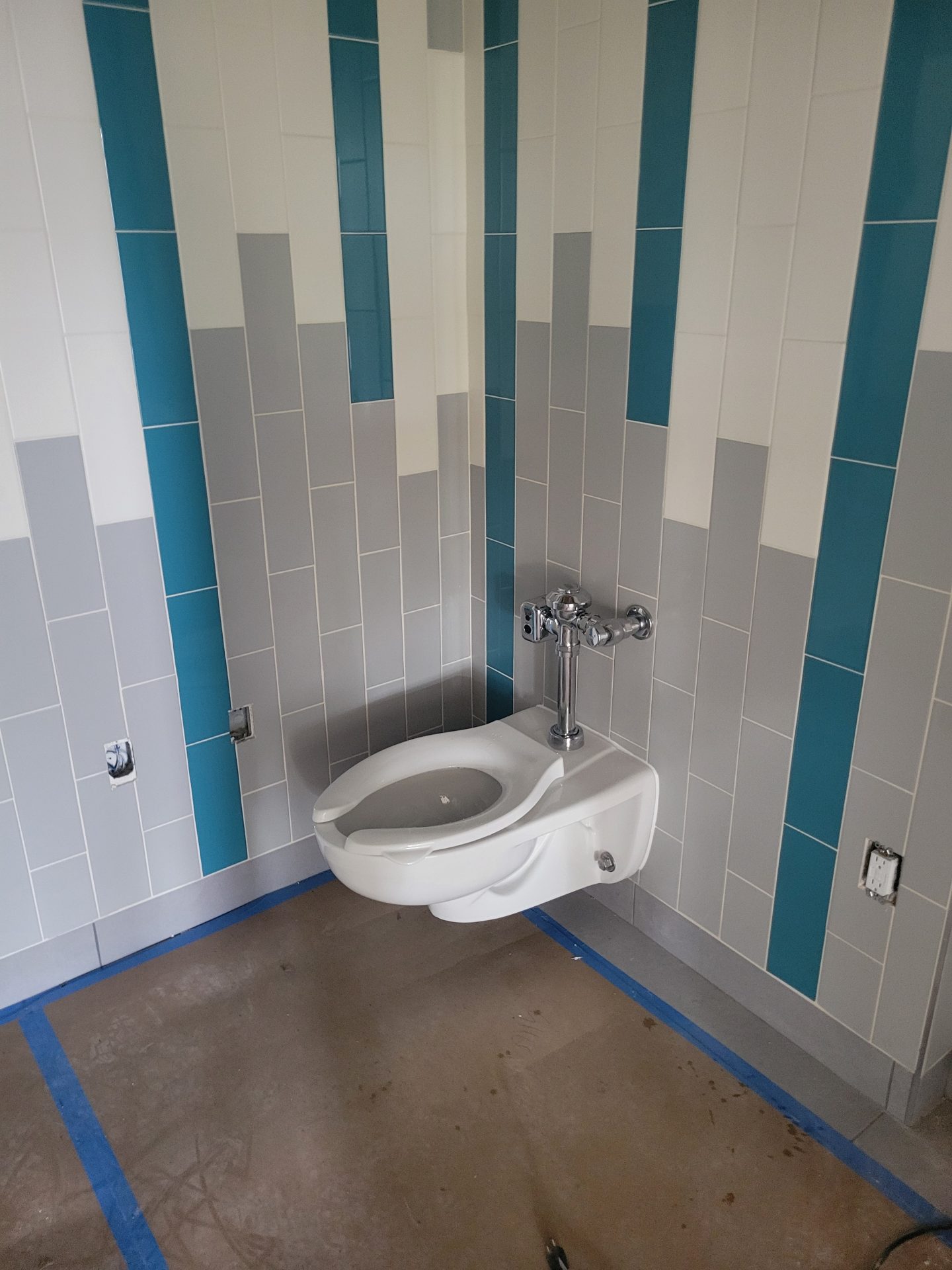

Toilet added to the family bathroom!

Image for timeline date 9/25/2025

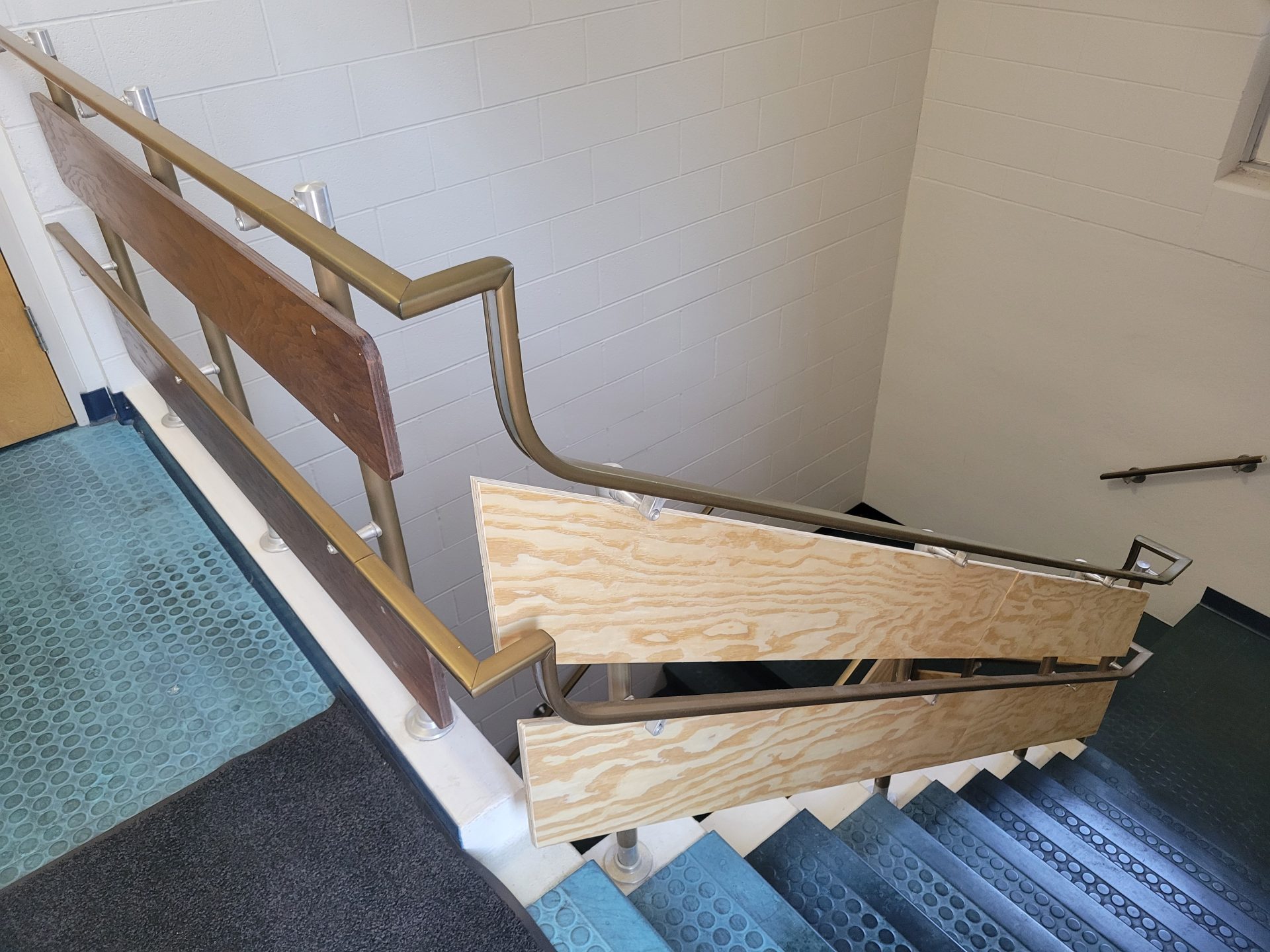

Safety features added to temporary stairway to lower level!

Image for timeline date 9/25/2025

More brick gets added to outdoor patio area!

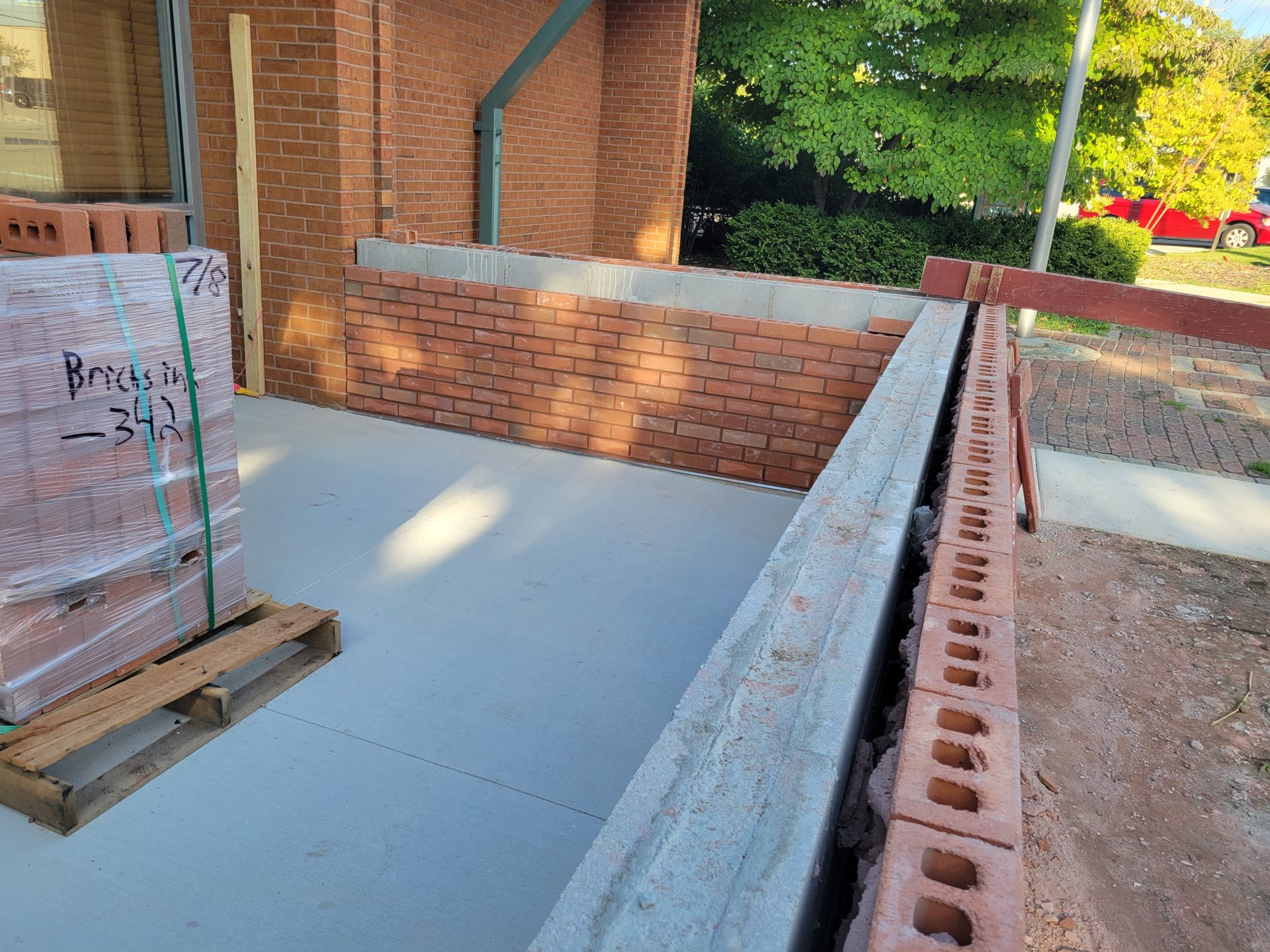

Image for timeline date 9/25/2025

Landscaping being done to new outdoor walkway!

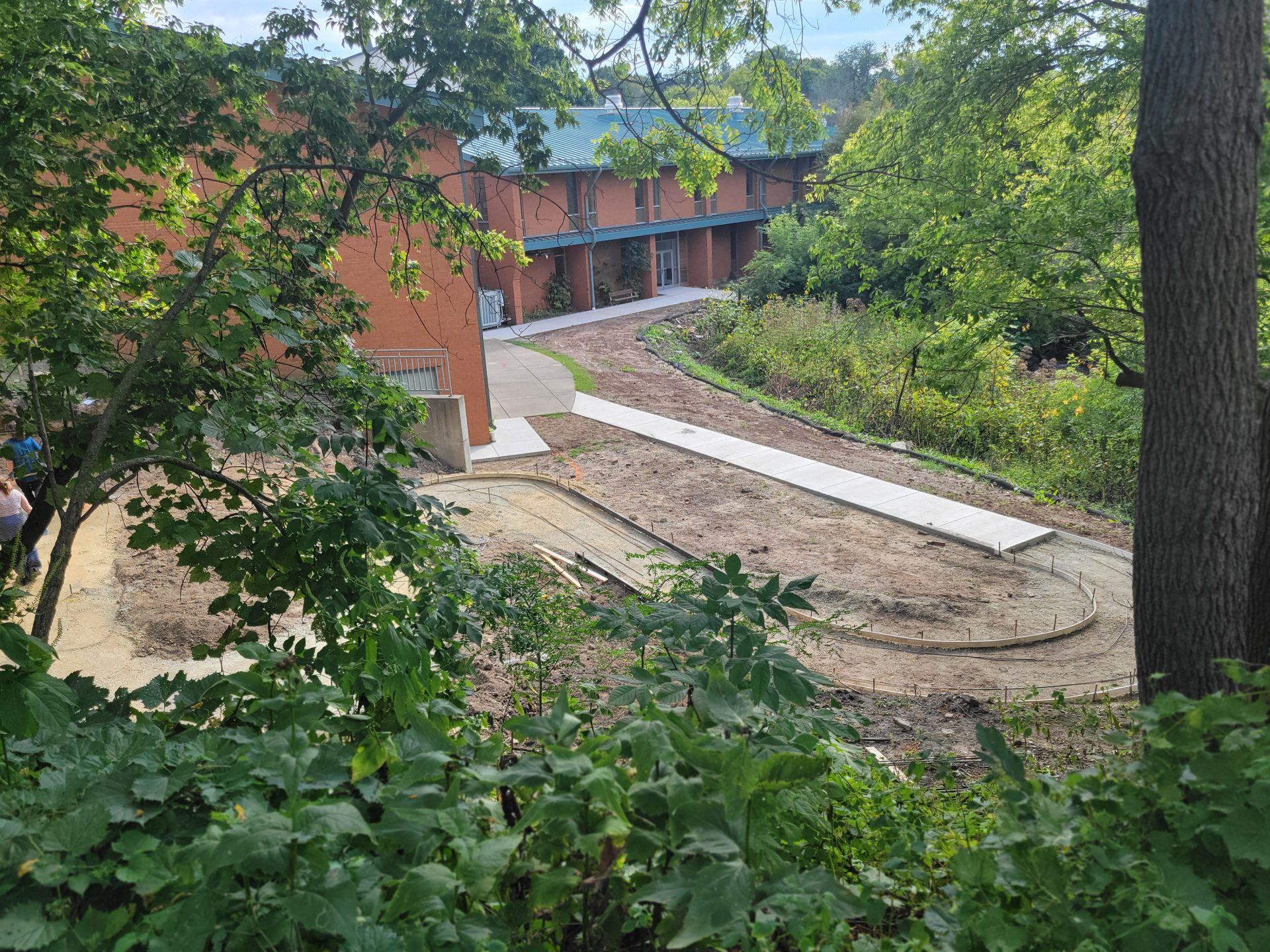

Image for timeline date 9/23/2025

Outdoor path now connects to the Northwest Trail!

Image for timeline date 9/23/2025

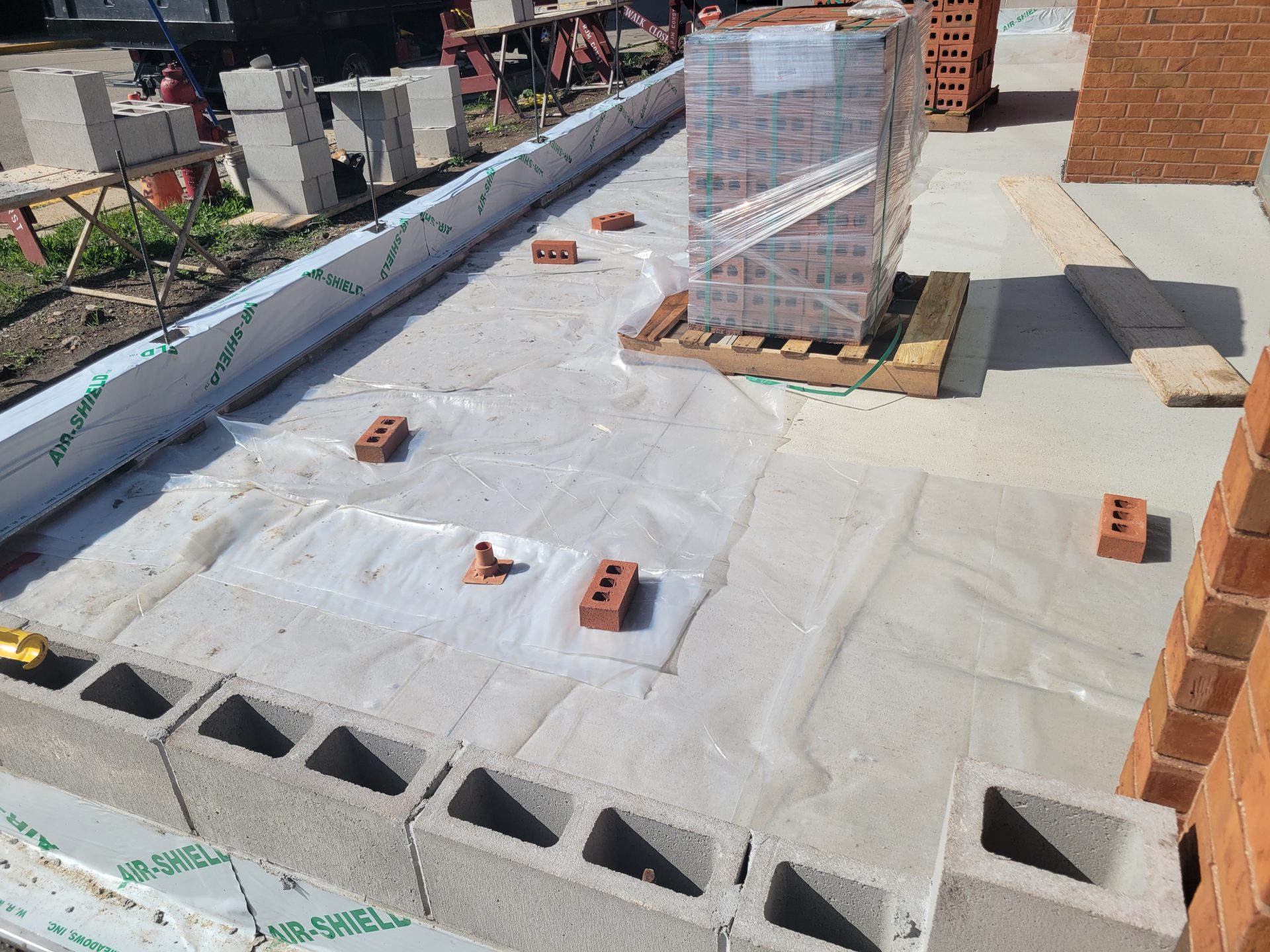

Bricks are being added to the outdoor patio!

Image for timeline date 9/23/2025

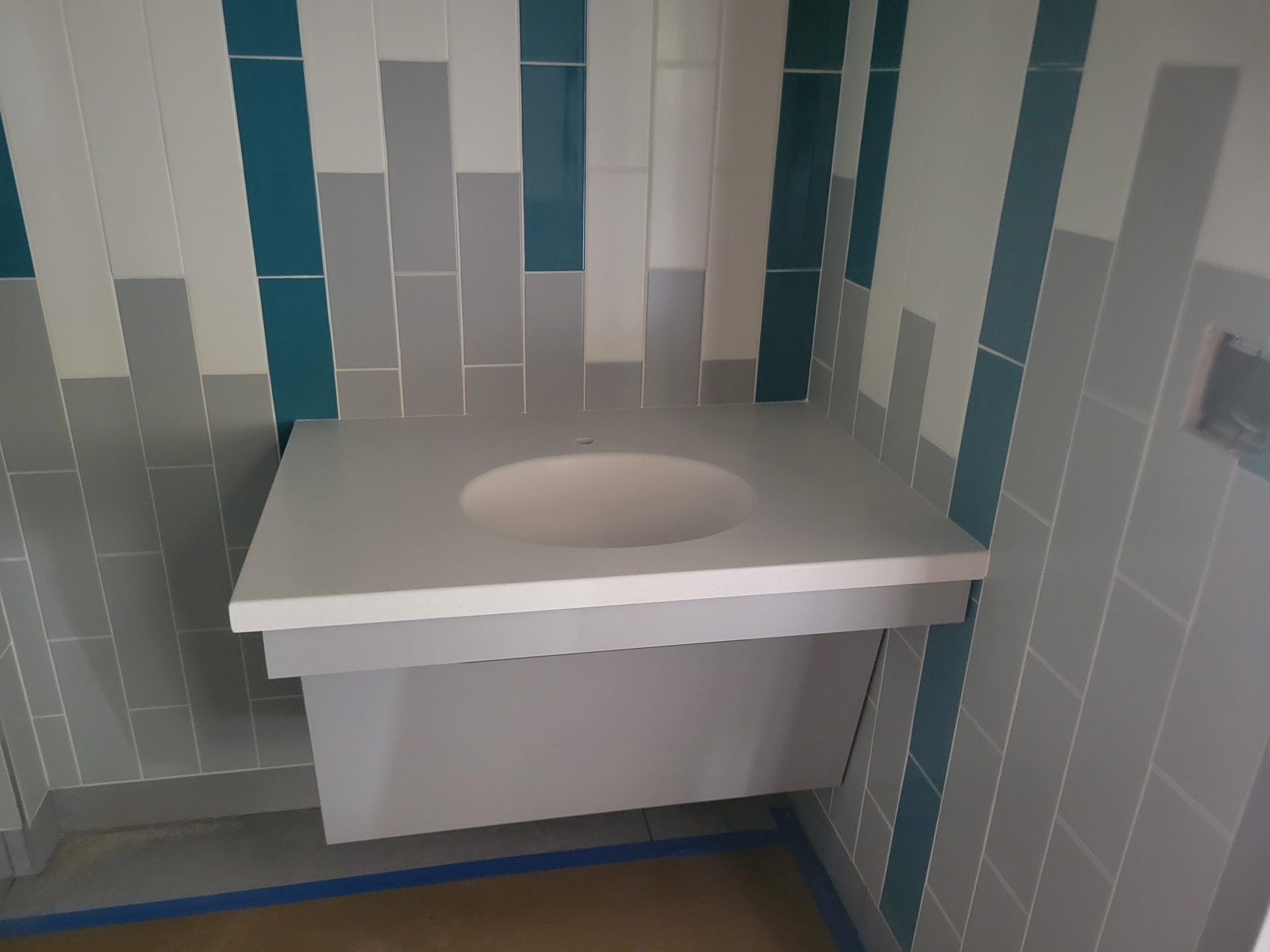

Sinks and counters added to bathroom and Caring Corner in Children's Department!

Image for timeline date 9/17/2025

Walkway is almost finished up to the Northwestern Trail!

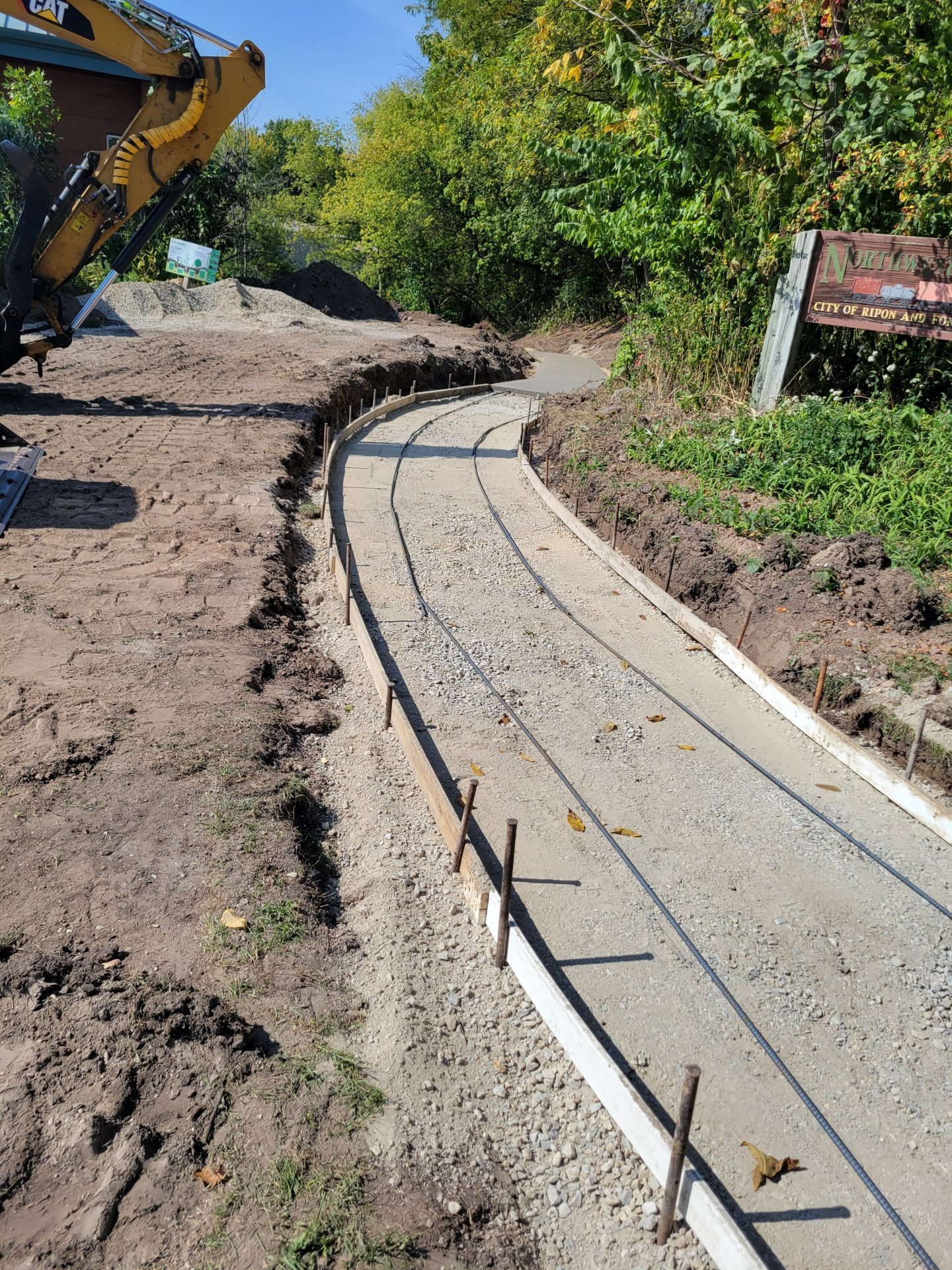

Image for timeline date 9/16/2025

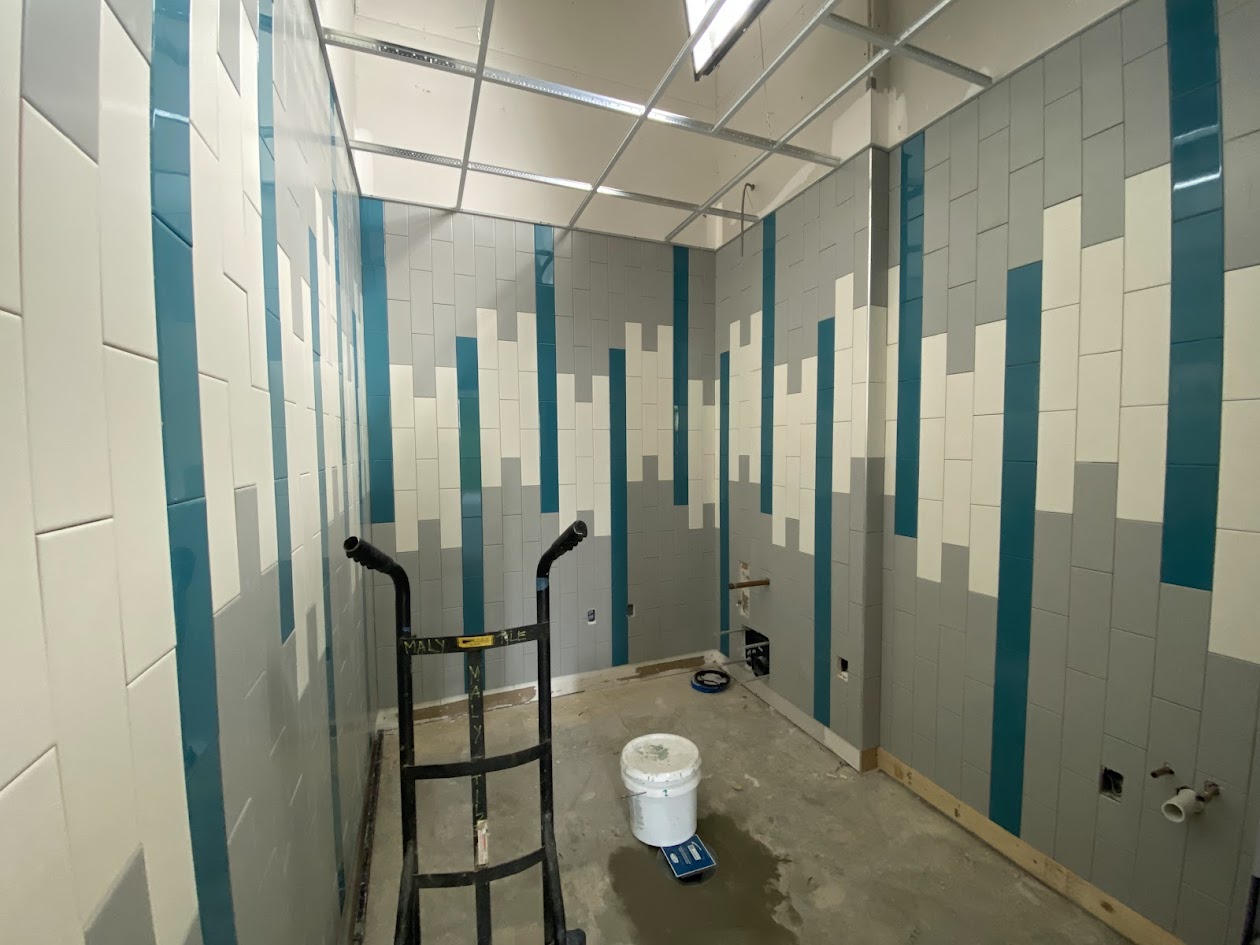

Floor and wall tiling complete!

Image for timeline date 9/15/2025

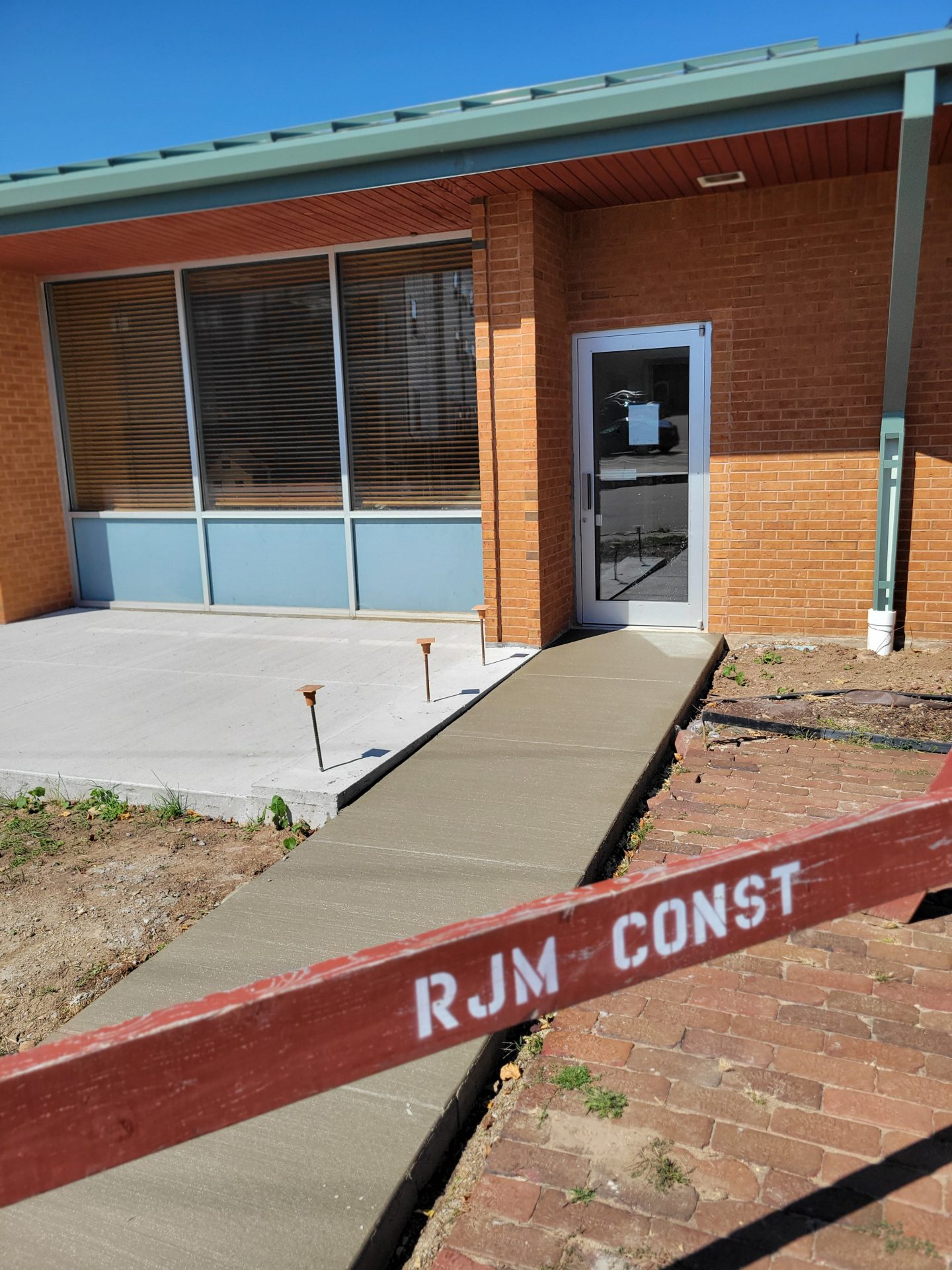

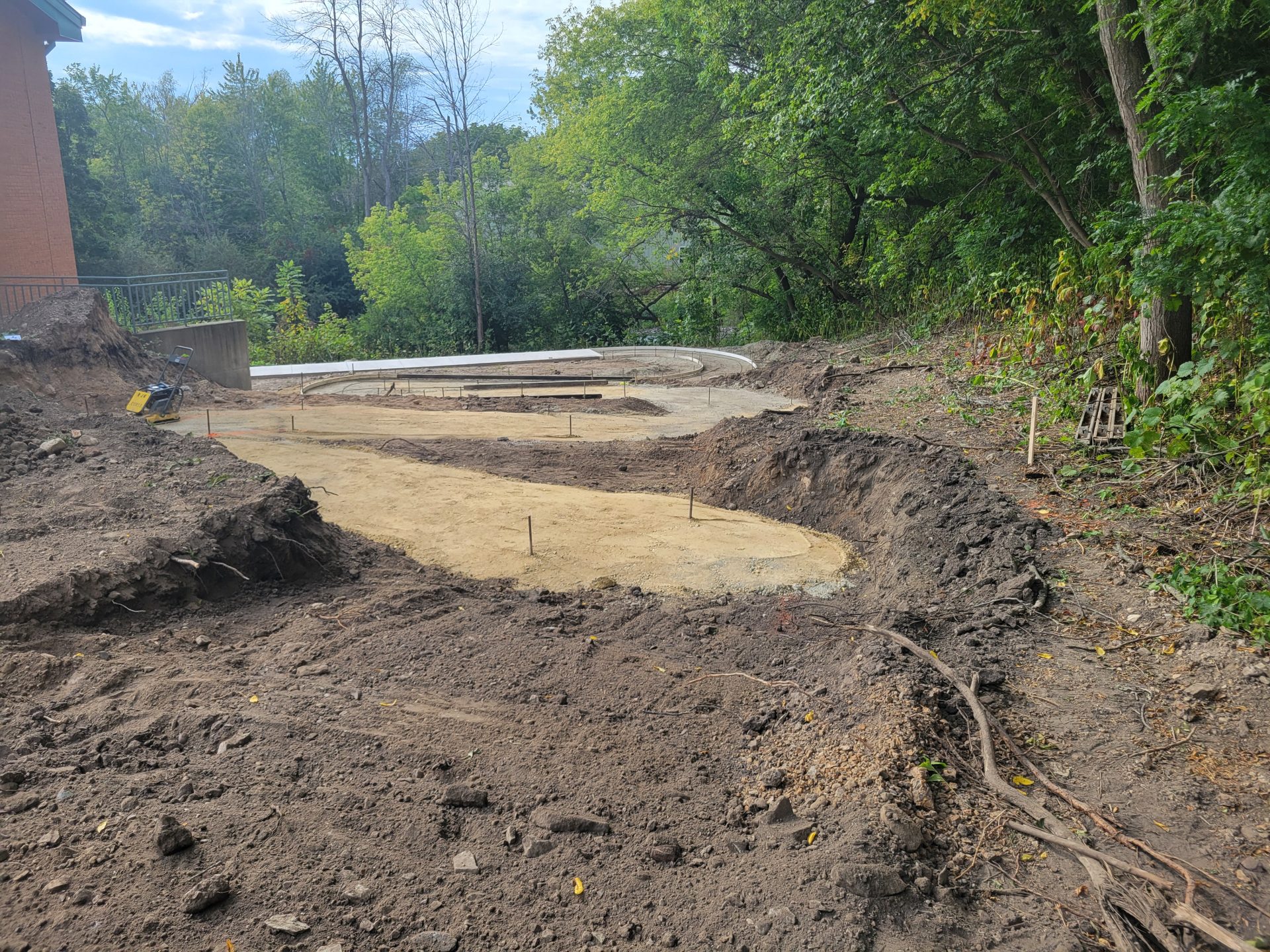

Concrete is poured for sidewalk. This will be our new temporary entrance!

Image for timeline date 9/15/2025

Adding curves to the outdoor path!

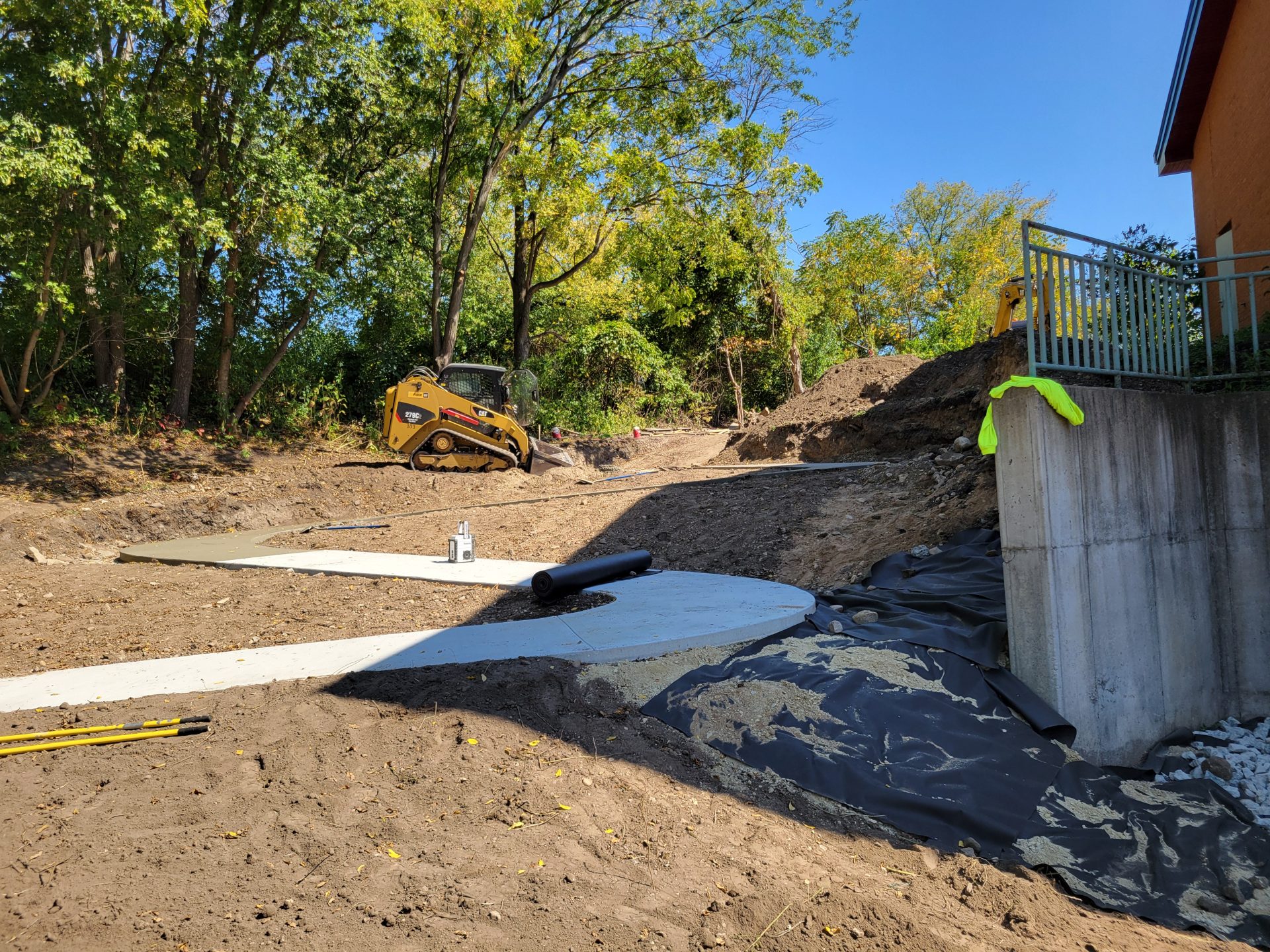

Image for timeline date 9/11/2025

Tiling is up in the Family bathroom!

Image for timeline date 9/10/2025

Adding paint to the Caring Corner in the Children's Department!

Making the path from the Northwestern Trail to Silver Creek!

Image for timeline date 9/10/2025

Bends added to path behind the library!

Image for timeline date 9/4/2025

More paint to add color to the Children's department

Image for timeline date 9/2/2025

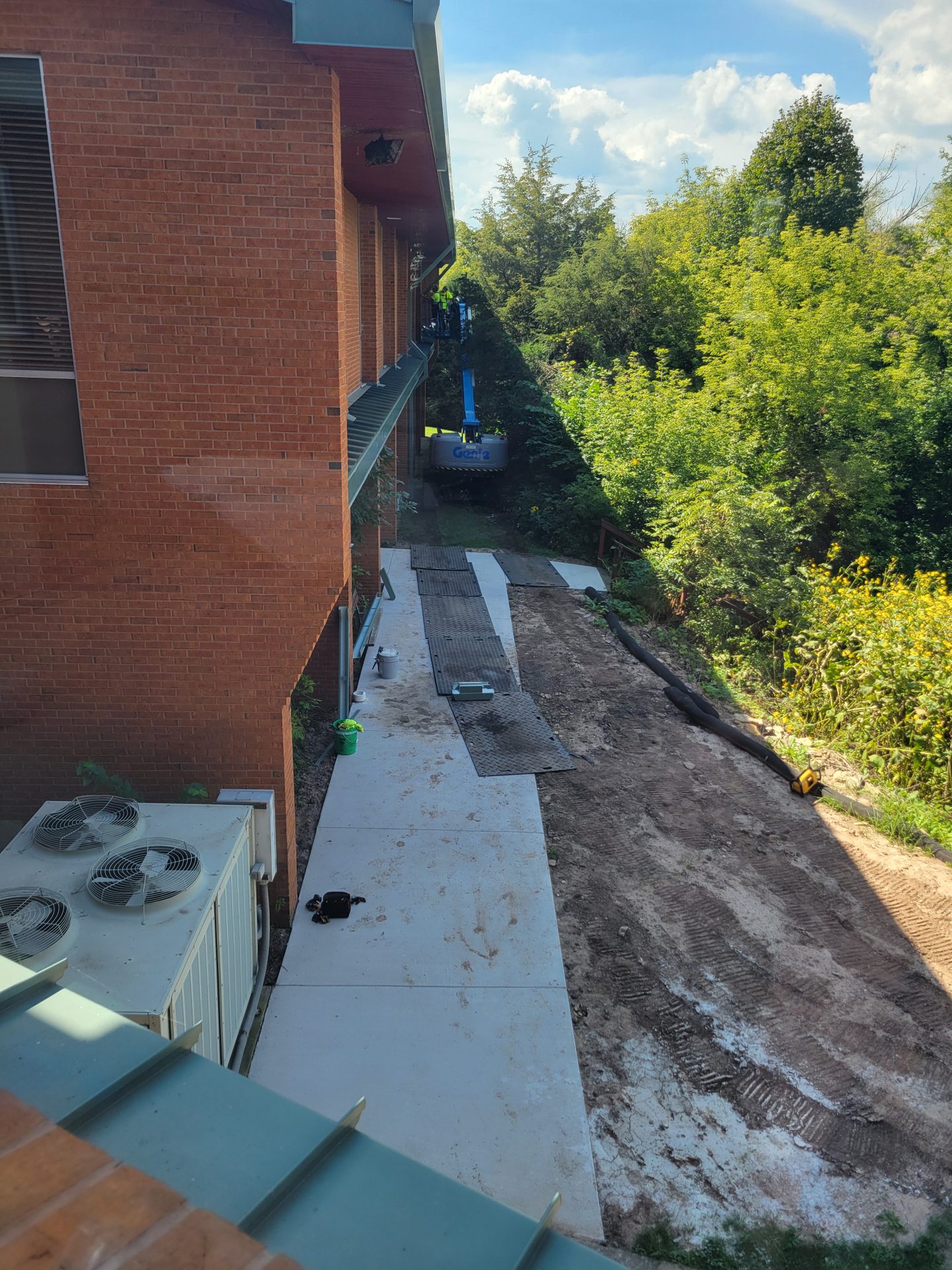

New gutters and snow guards on the back of the building

Image for timeline date 9/2/2025

Orange paint for the family bathroom and Caring Corner!

Image for timeline date 8/28/2025

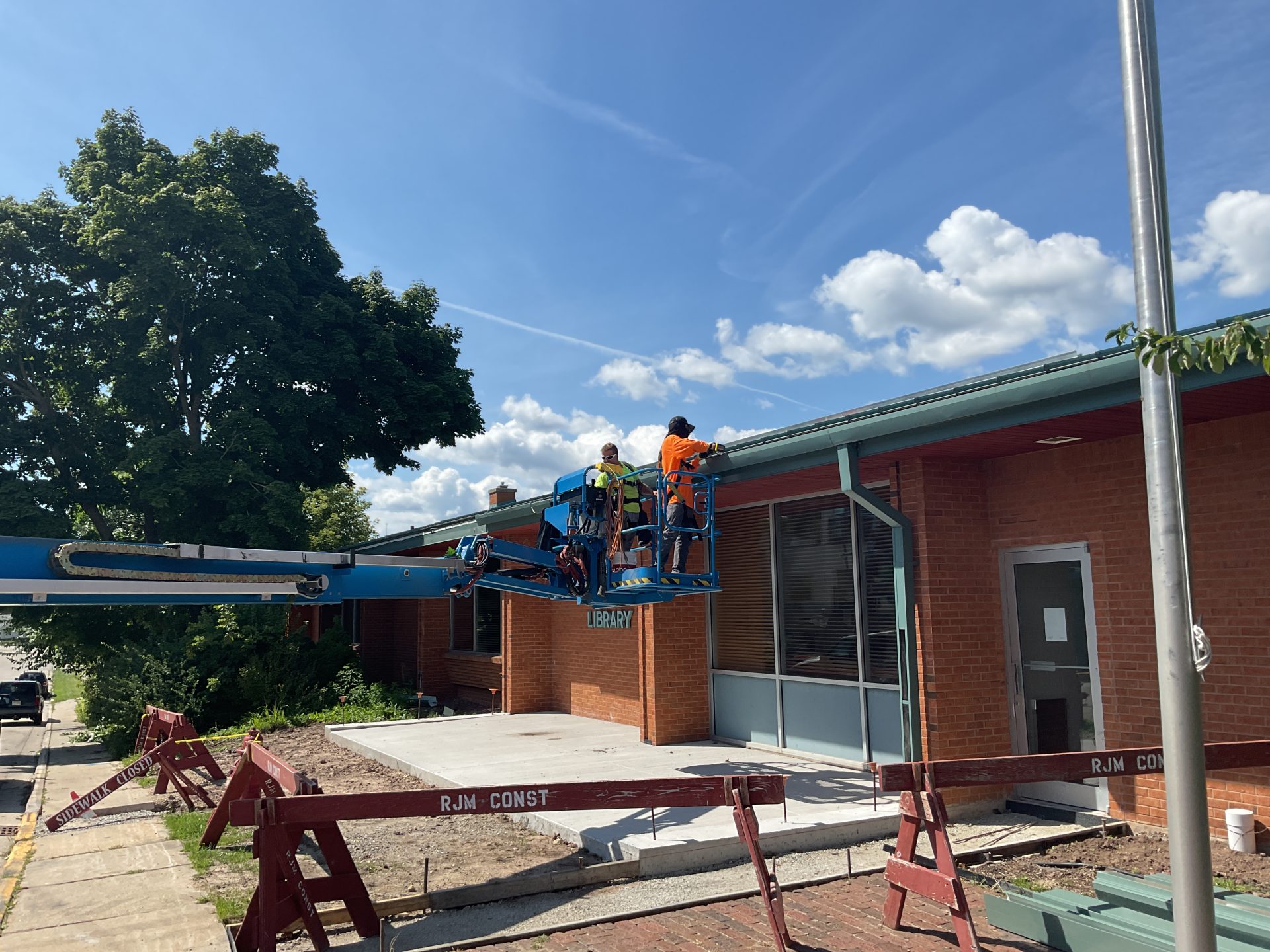

Installing new gutters and snow guards

Image for timeline date 8/25/2025

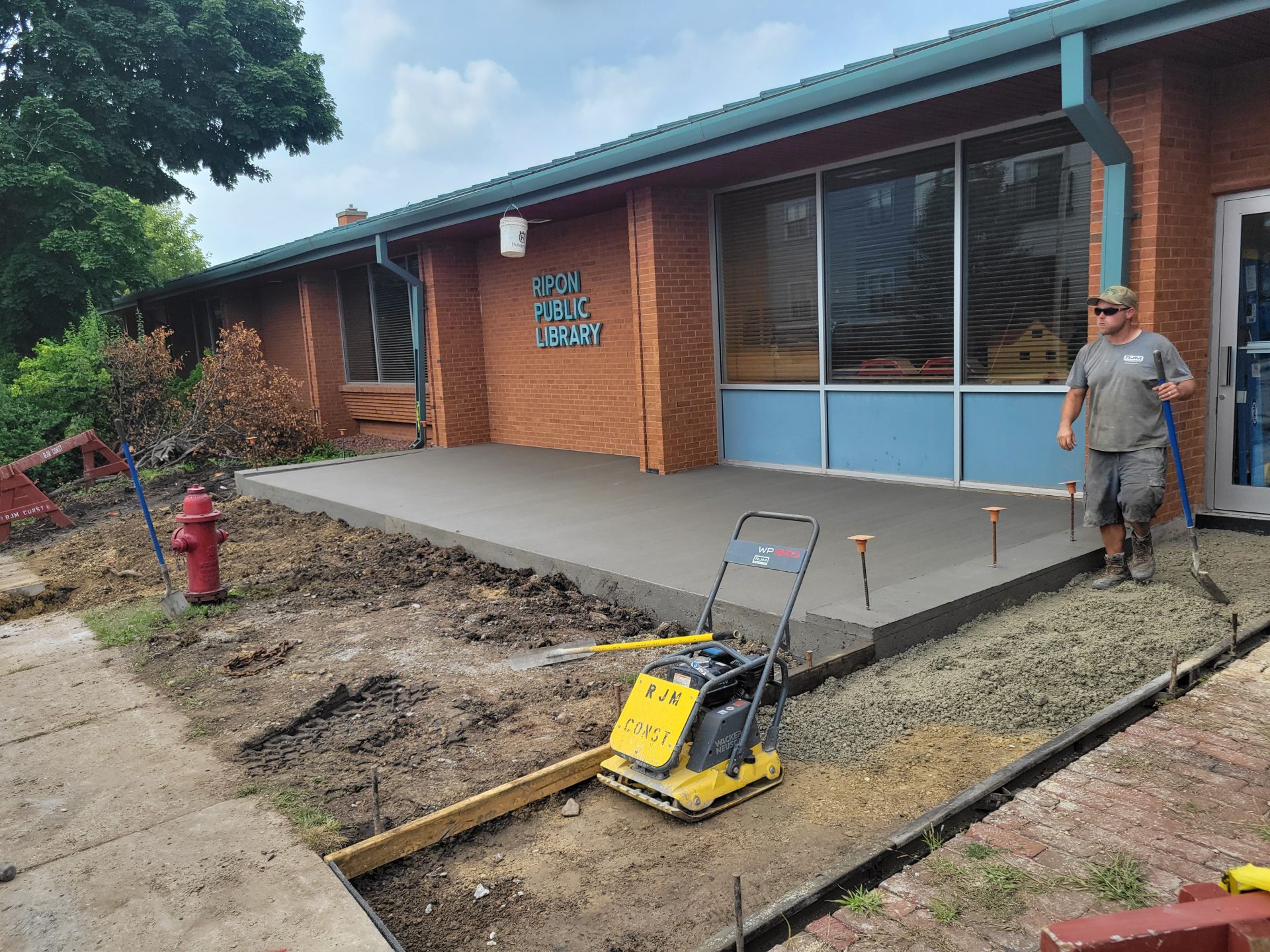

Front patio cement in place

Image for timeline date 8/7/2025

Back sidewalk added

Image for timeline date 8/7/2025

Framing in place for new restrooms

Image for timeline date 8/6/2025

Ceiling tiles came out!
